The house is done! Painting, customizing and moving have started. |
| |
| | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | |
01/20/2023 | 01/20/2023 | 01/20/2023 | 01/20/2023 | 01/20/2023 | 01/20/2023 | 01/14/2023 | 01/10/2023 | 01/10/2023 | 01/10/2023 |
| | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | |
| | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | |
01/08/2023 | 01/08/2023 | 01/08/2023 | 01/08/2023 | 01/08/2023 | 01/08/2023 | 01/08/2023 | 01/08/2023 | 01/08/2023 | 01/07/2023 |
| | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | |
| | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | |

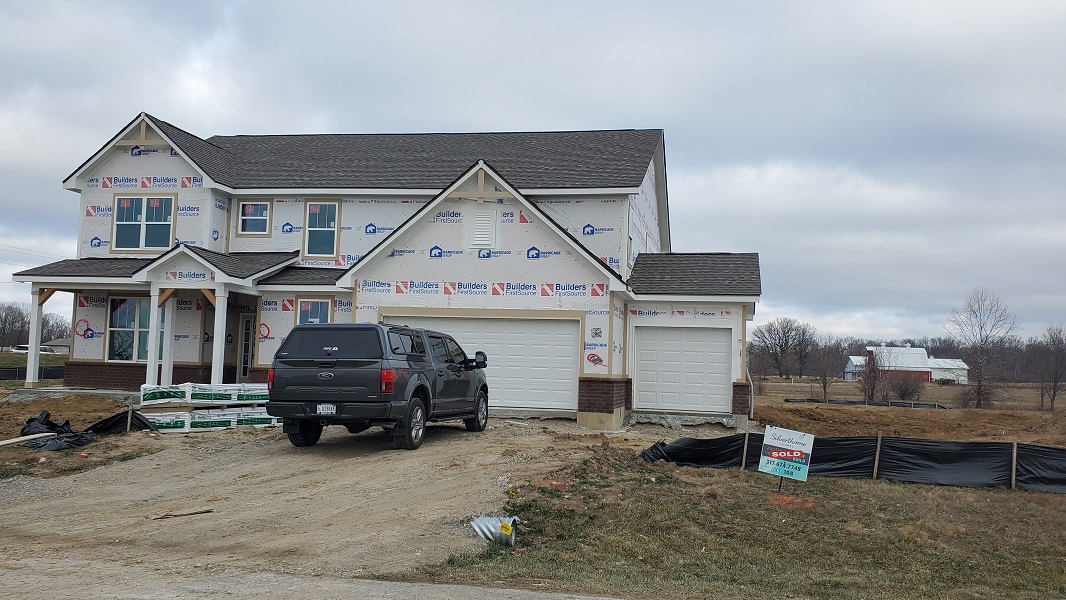

12/21/2022 | 12/21/2022 | 12/21/2022 | 12/21/2022 | 12/21/2022 | 12/21/2022 | 12/18/2022 | 12/18/2022 | 12/18/2022 | 12/18/2022 |
| | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | |
| | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | |

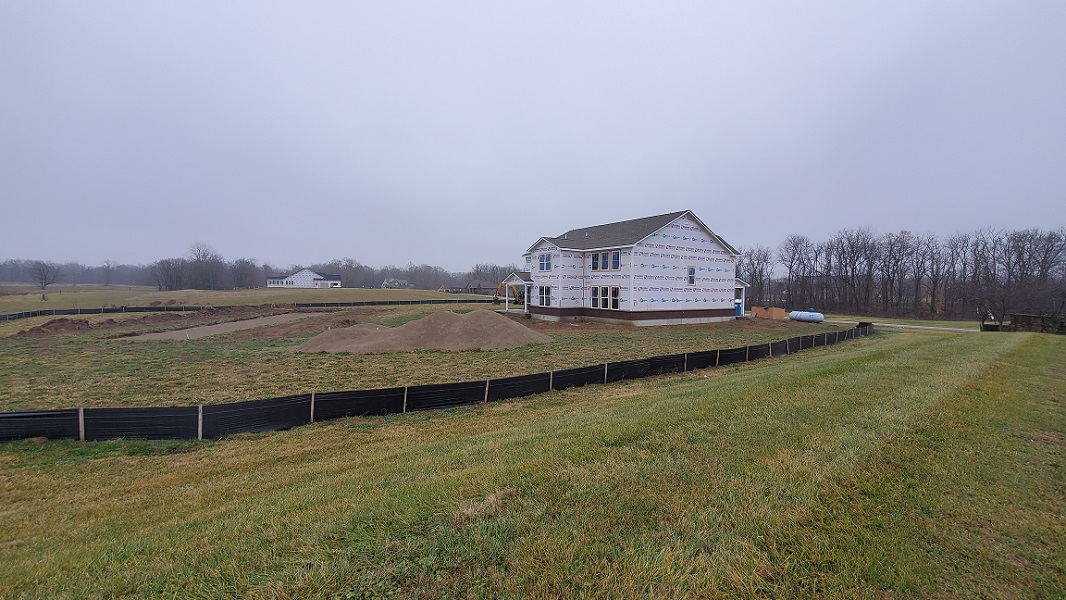

12/18/2022 | 12/18/2022 | 12/10/2022 | 12/10/2022 | 12/10/2022 | 12/04/2022 | 11/26/2022 | 11/13/2022 | 10/26/2022 | 10/26/2022 |
| | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | |
| | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | |

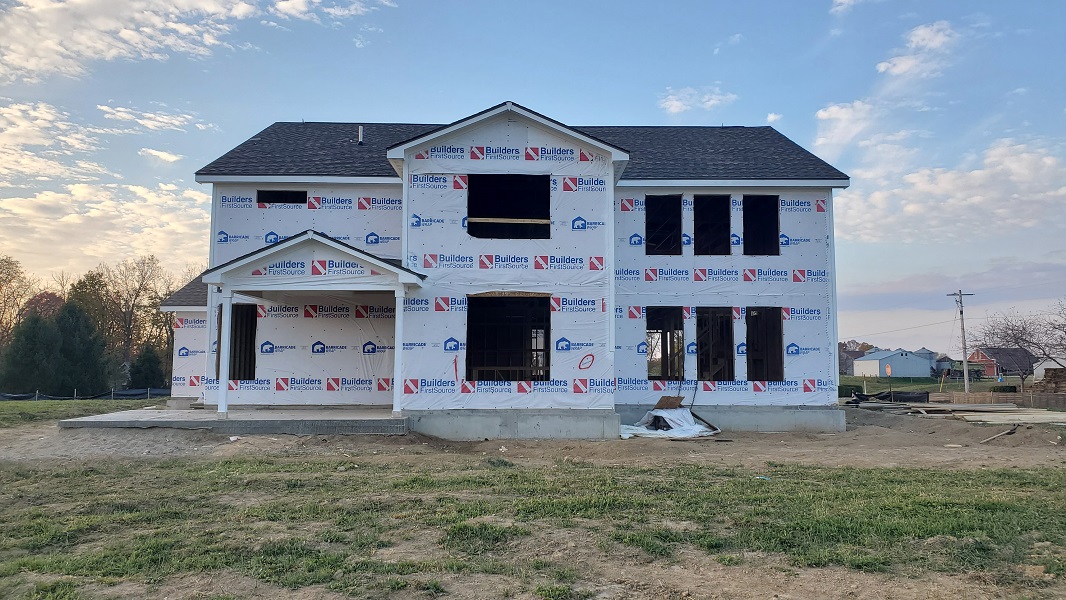

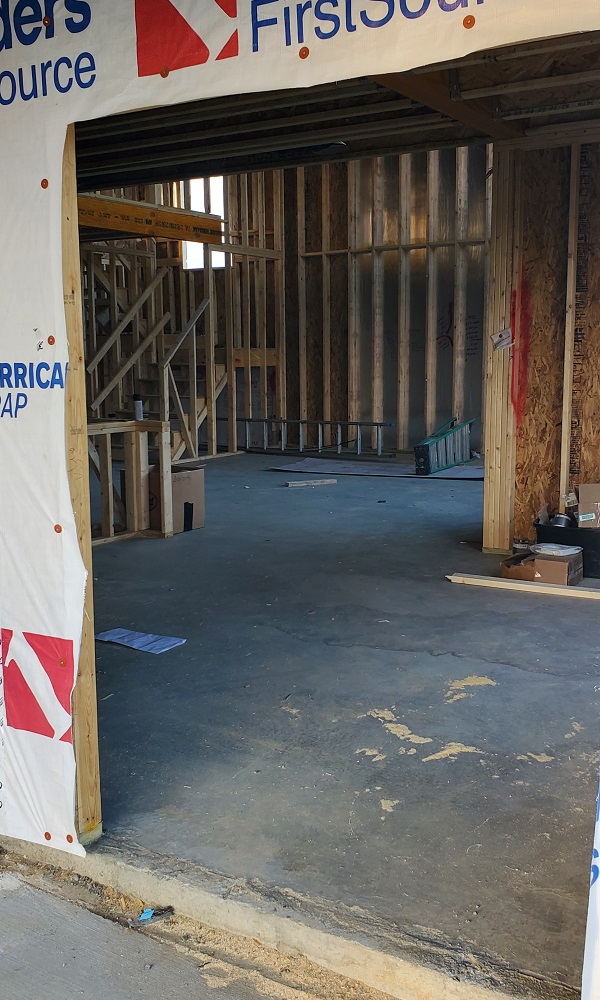

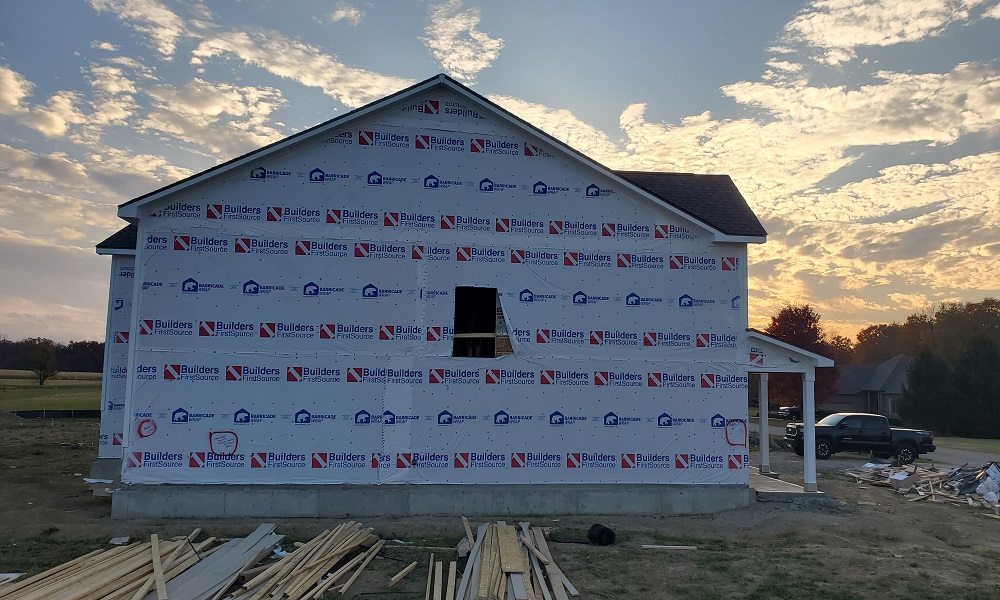

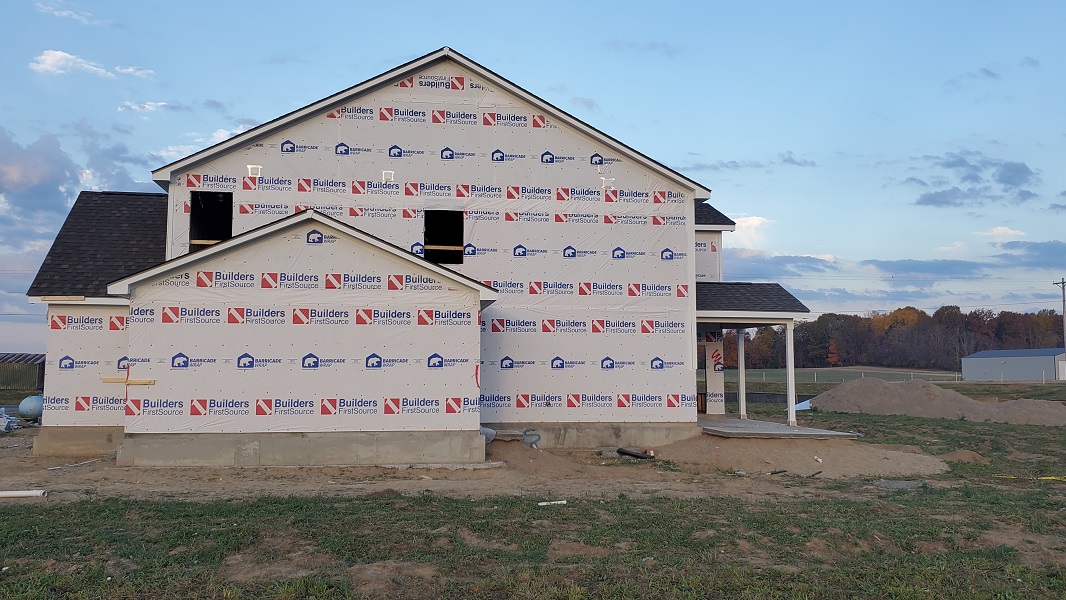

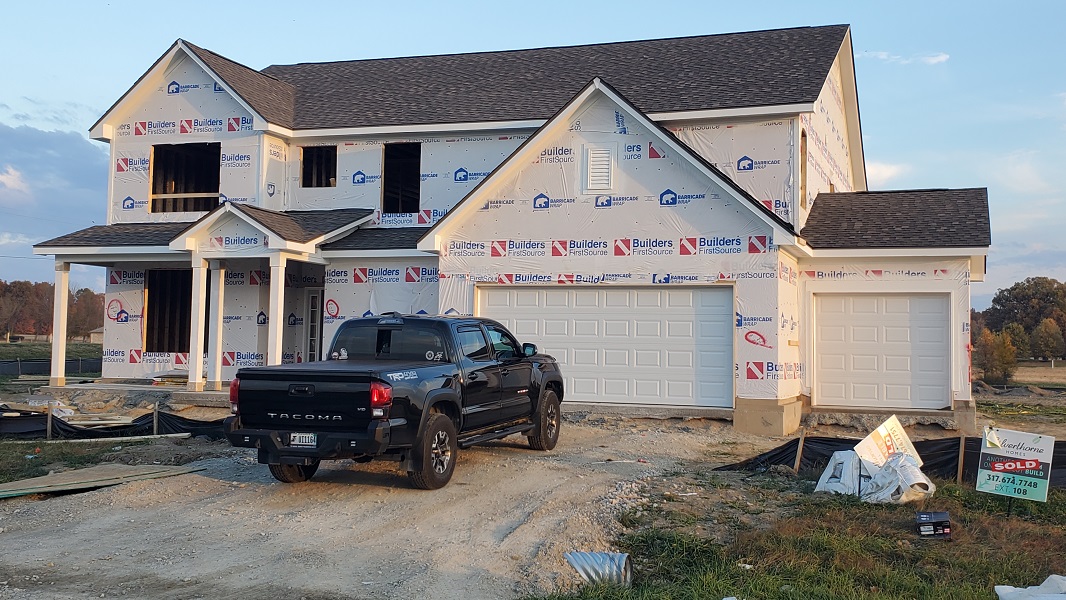

10/23/2022 | 10/23/2022 | 10/23/2022 | 10/23/2022 | 10/23/2022 | 10/23/2022 | 10/23/2022 | 10/23/2022 | 10/23/2022 | 10/20/2022 |
| | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | |
| | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | |
10/20/2022 | 10/18/2022 | 10/16/2022 | 10/16/2022 | 10/16/2022 | 10/16/2022 | 10/16/2022 | 10/16/2022 | 10/16/2022 | 10/13/2022 |
| | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | |
| | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | |

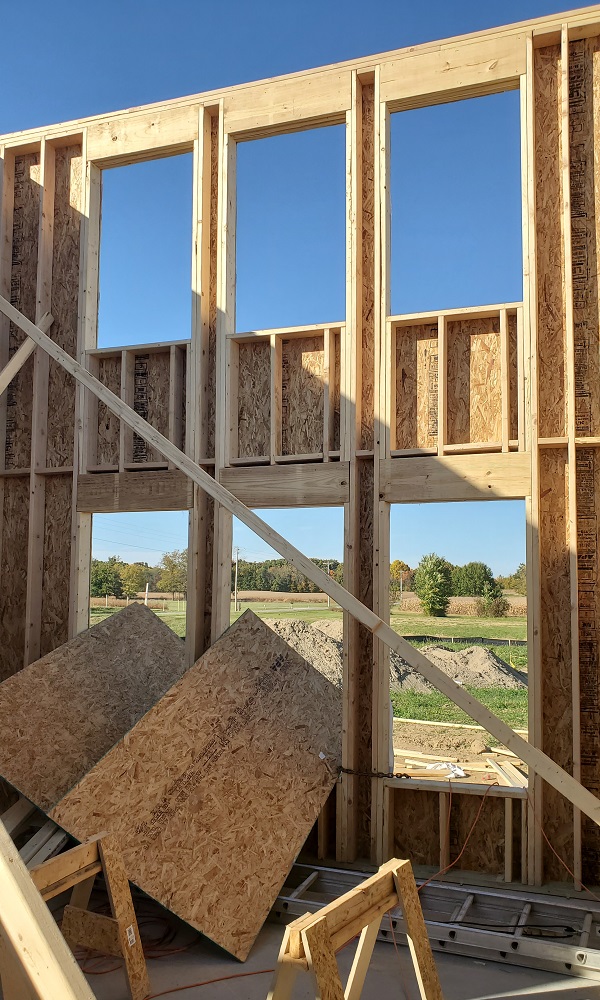

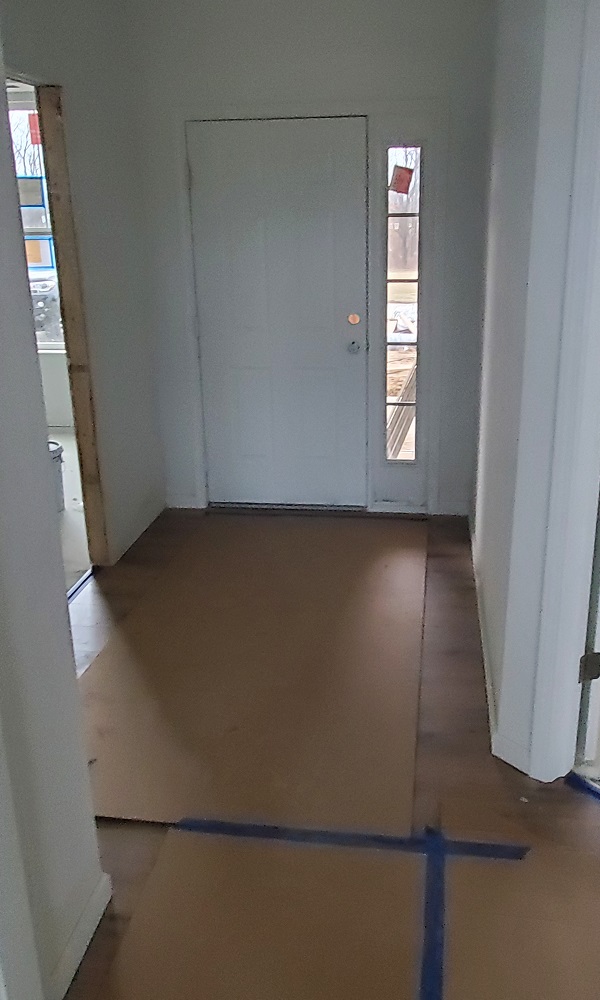

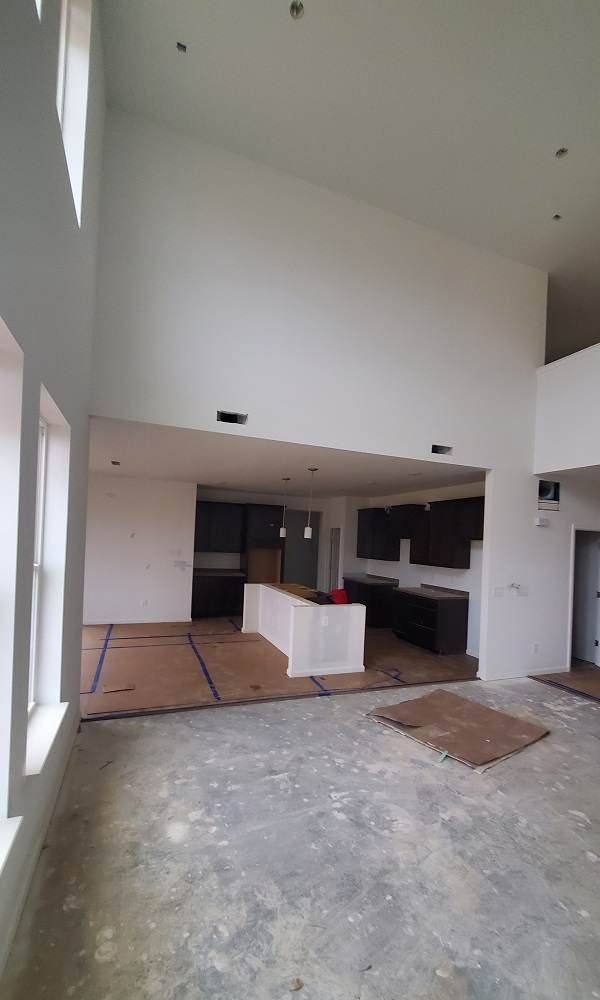

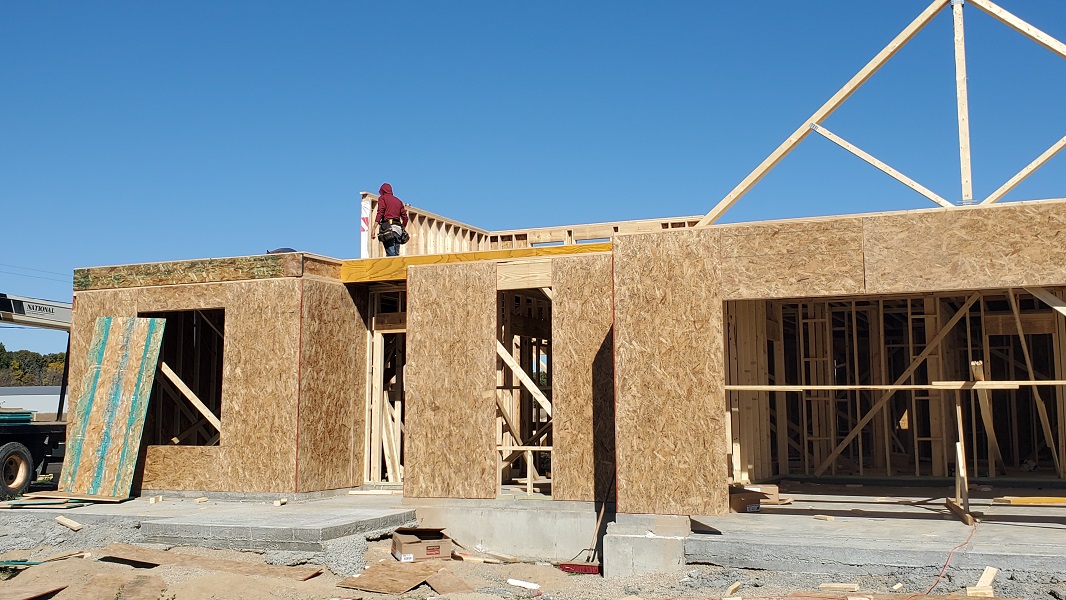

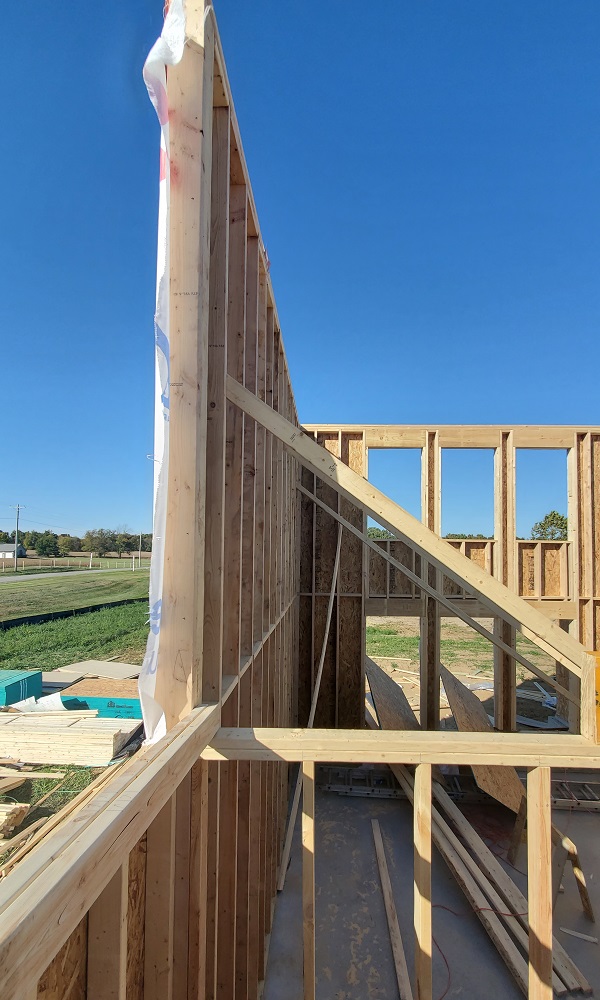

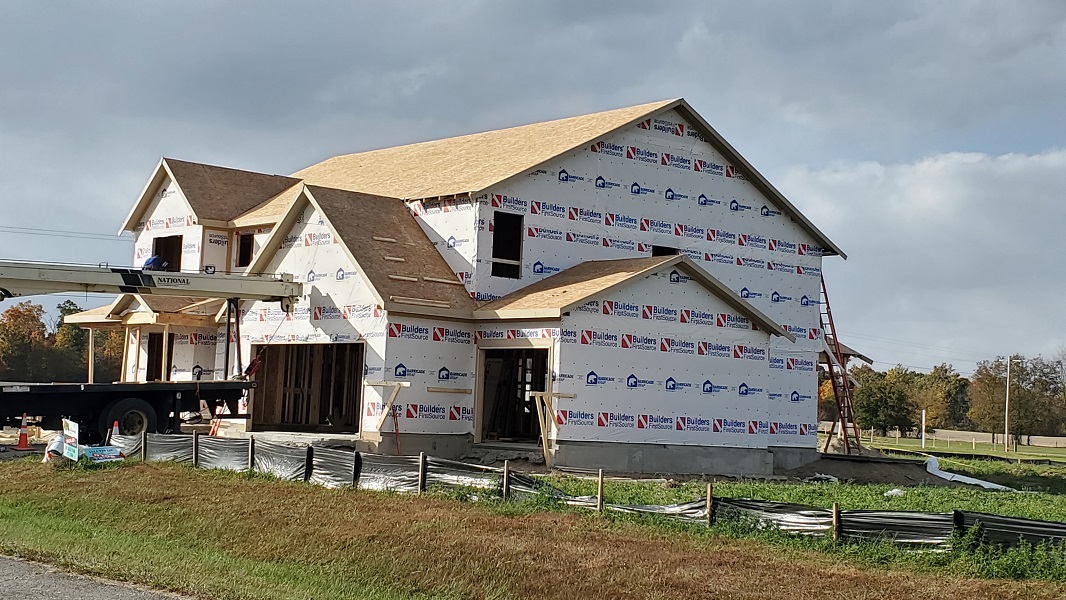

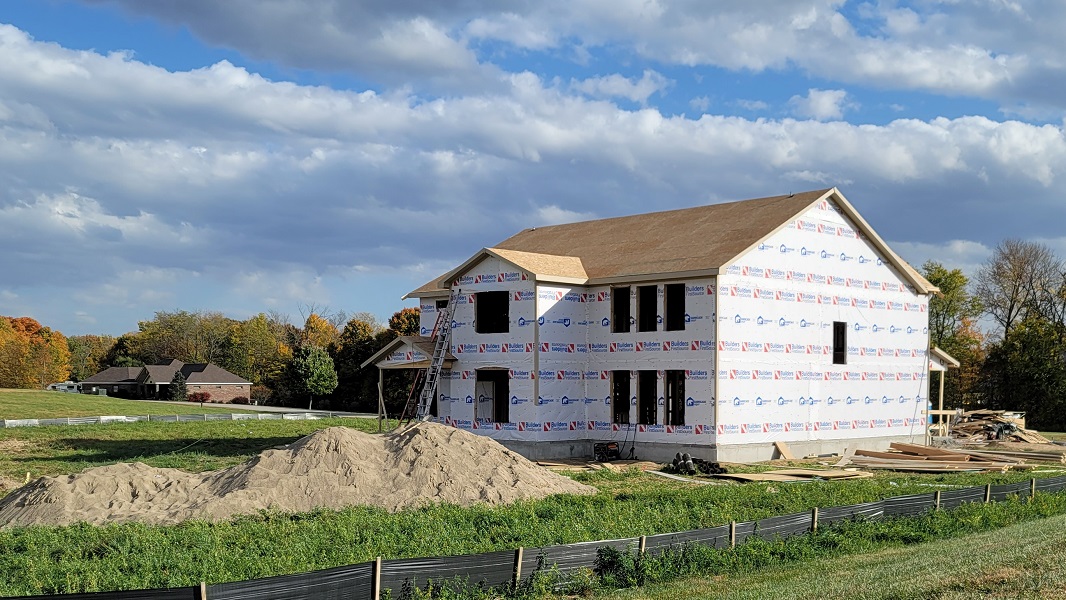

10/13/2022 | 10/10/2022 | 10/10/2022 | 10/09/2022 | 10/09/2022 | 10/09/2022 | 10/09/2022 | 10/09/2022 | 10/09/2022 | 10/09/2022 |
| | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | |
| | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | |

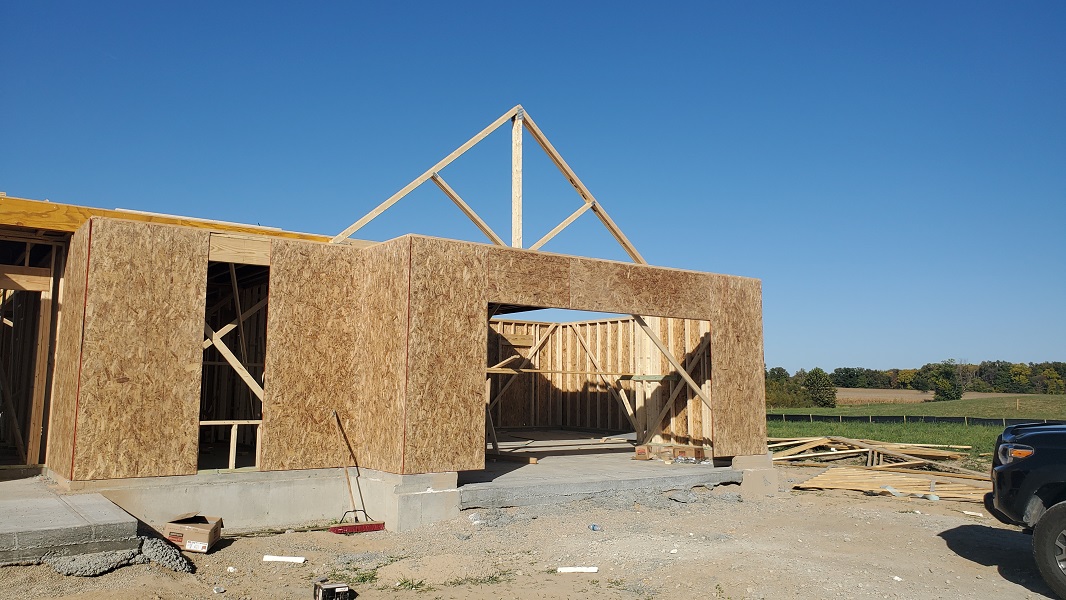

10/06/2022 | 10/06/2022 | 10/02/2022 | 10/02/2022 | 09/17/2022 | 08/25/2022 | 08/22/2022 | 04/30/2022 | 02/24/2022 | 01/20/2022 |
| | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | | |
|
NEXT STEPS: Finish the details, final walk-through, closing and moving in!

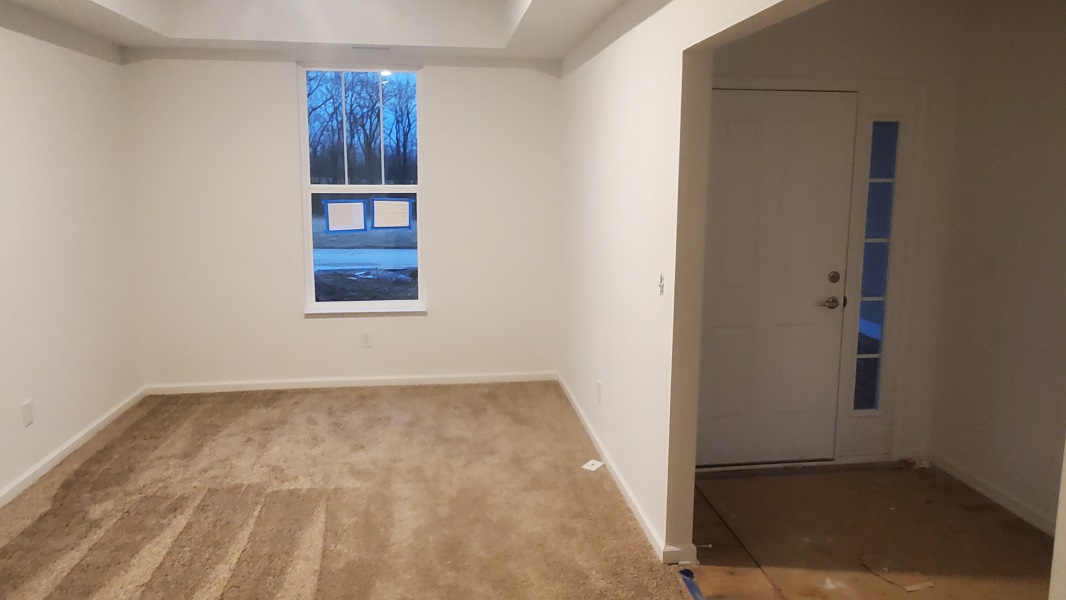

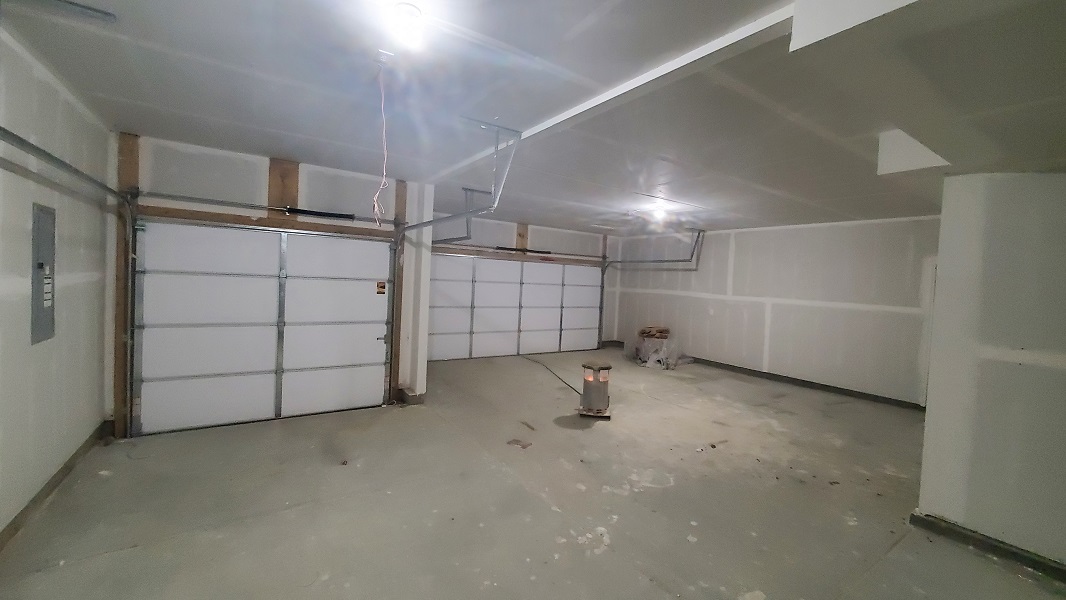

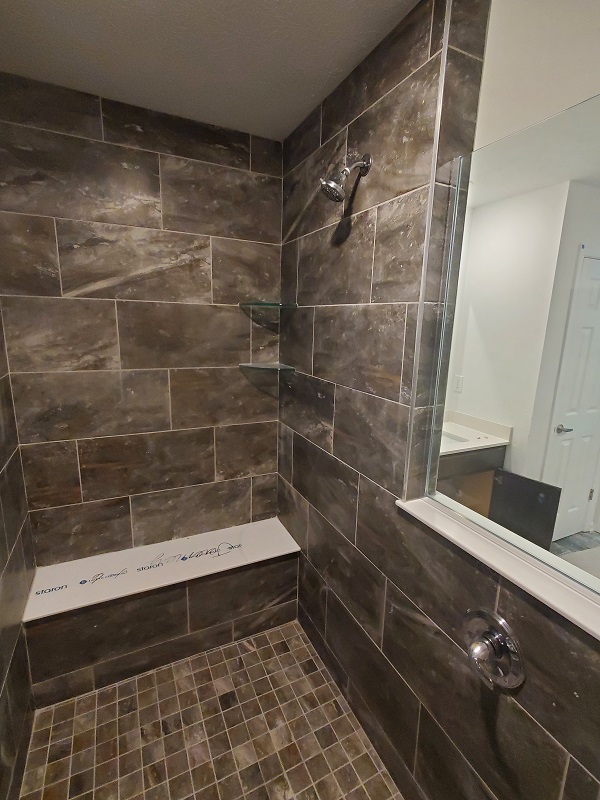

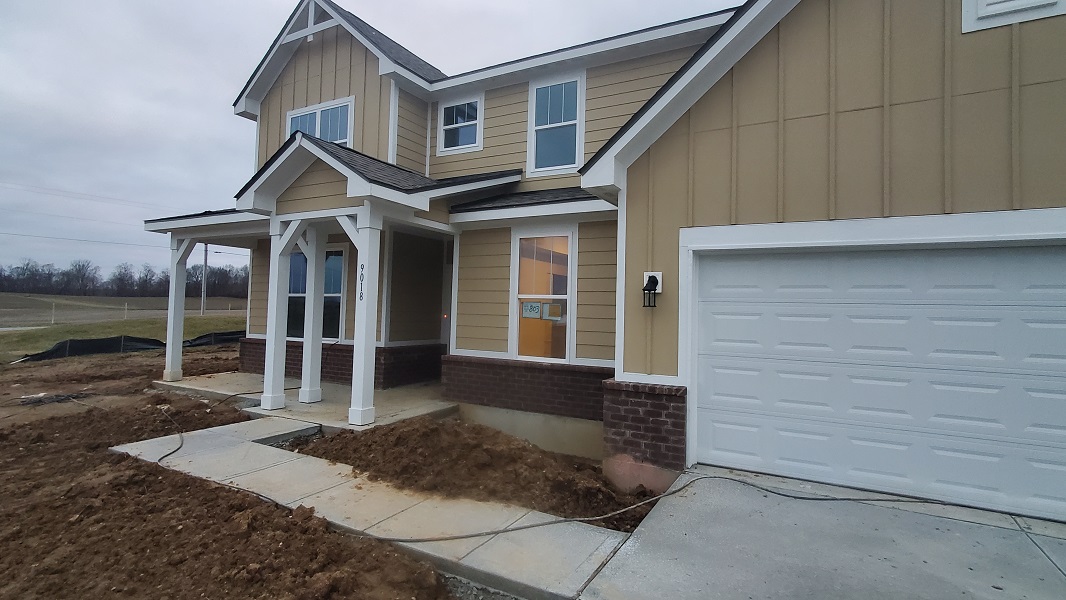

20 Jan 2023: Water and electricity have been hooked up.

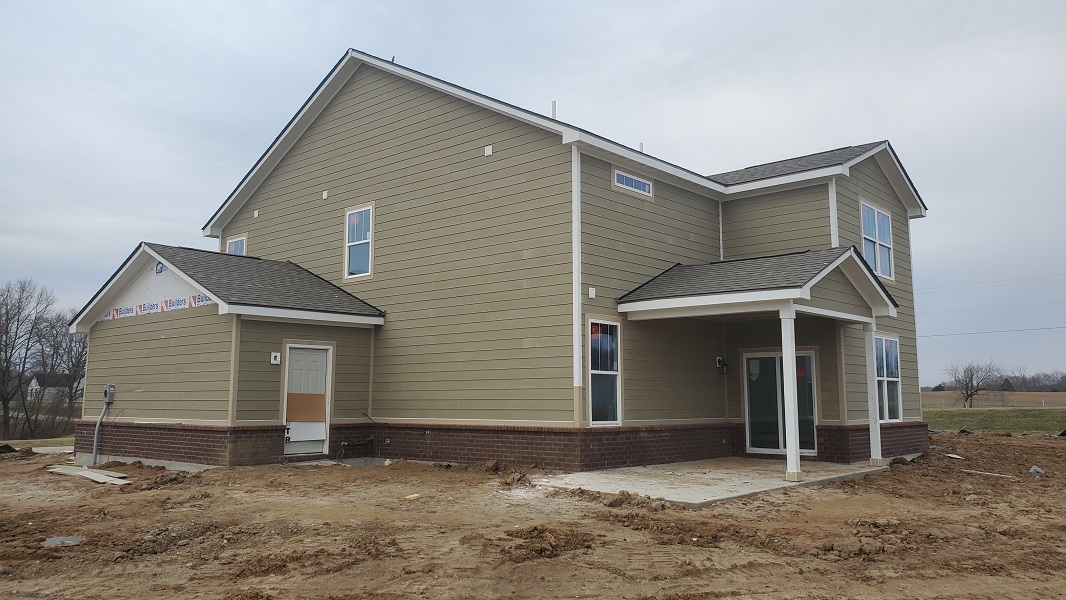

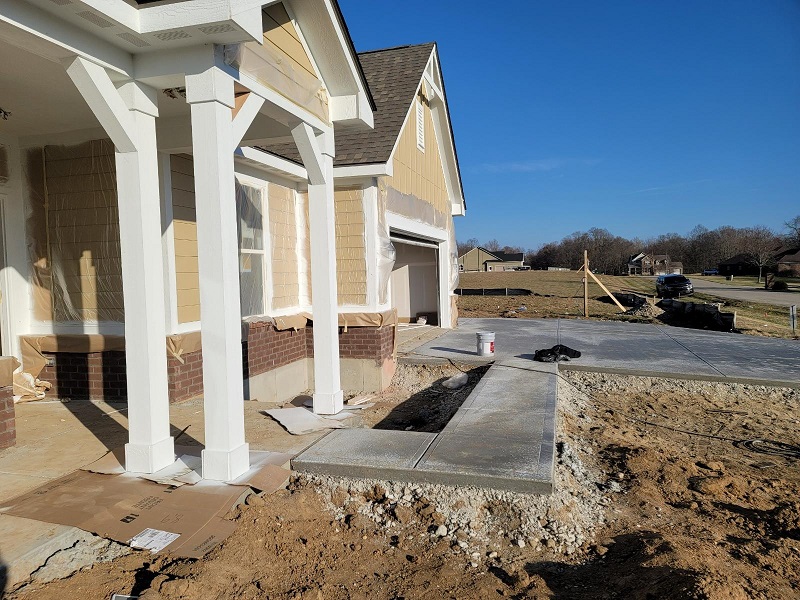

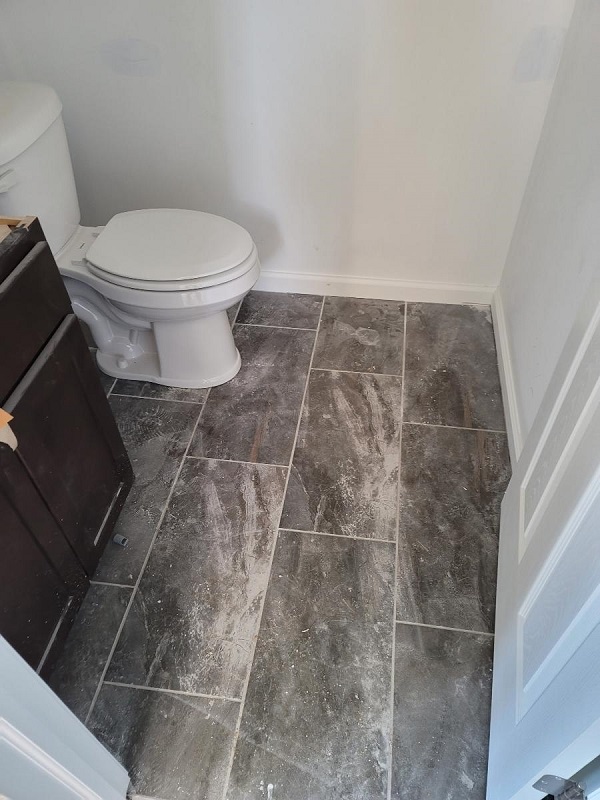

10 Jan 2023: Siding has been finished and a warm spell allowed the exterior to get painted and the driveway and sidewalk poured.

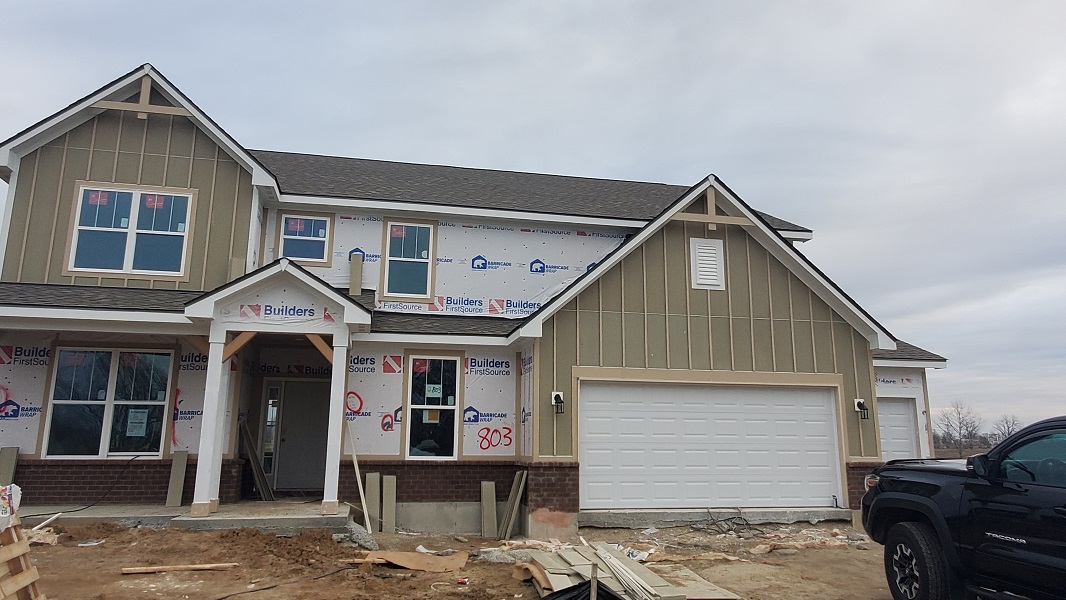

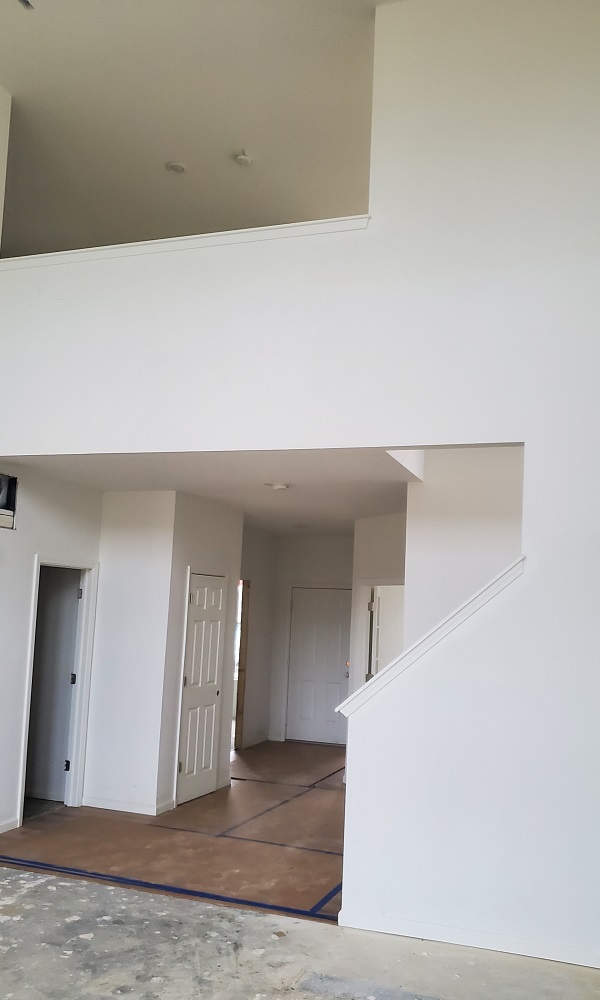

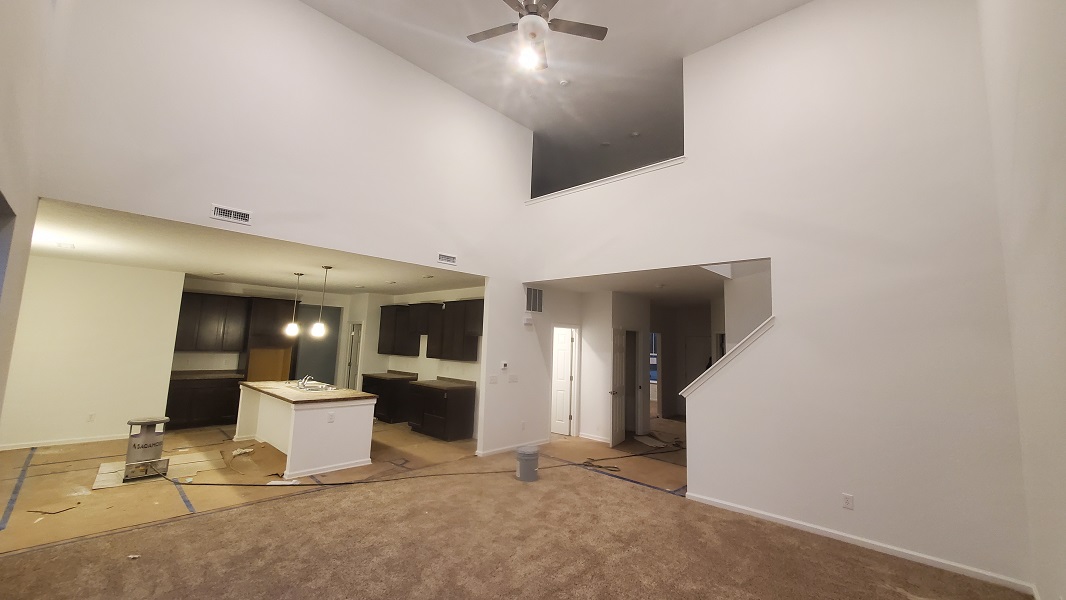

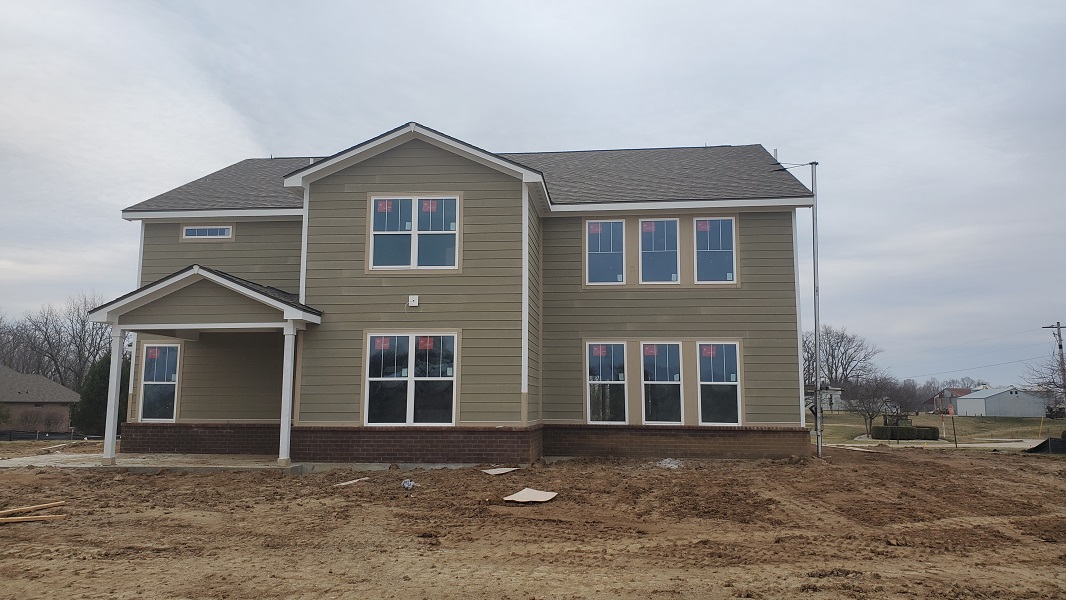

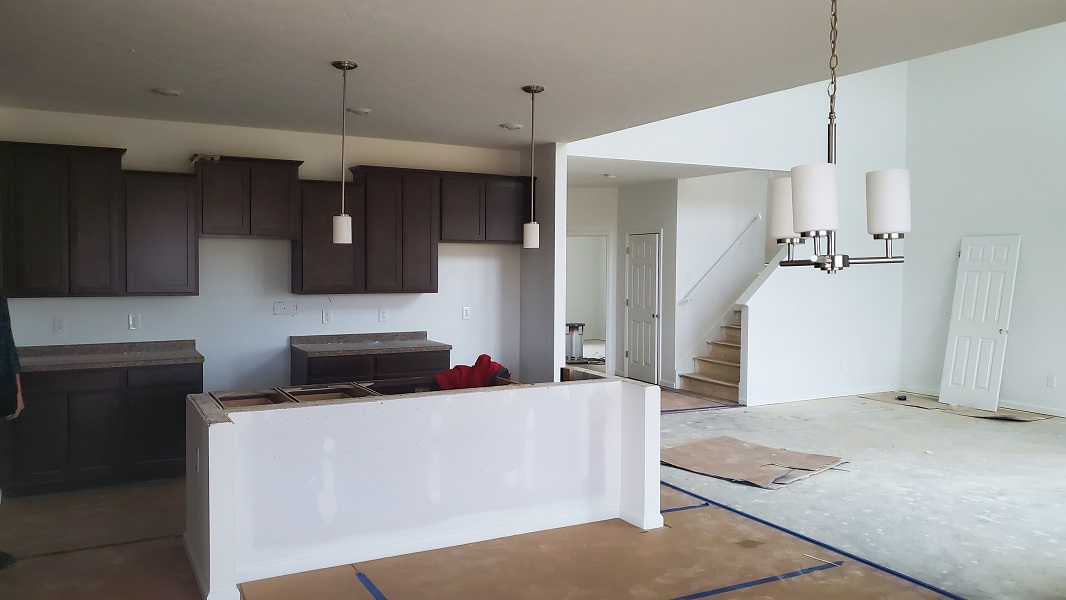

08 Jan 2023: Carpeting and cabinets have been installed.

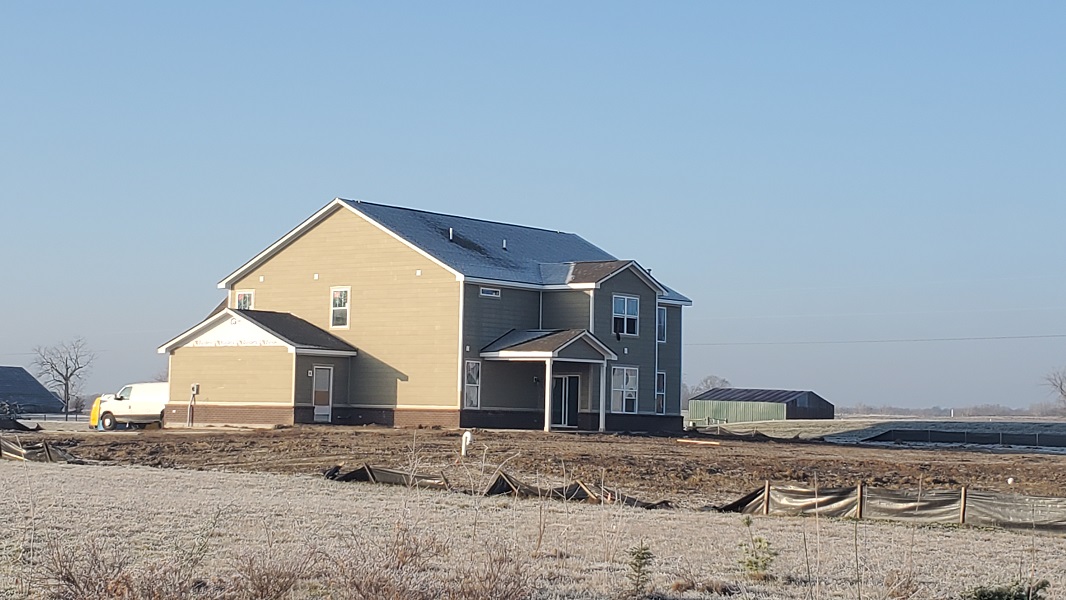

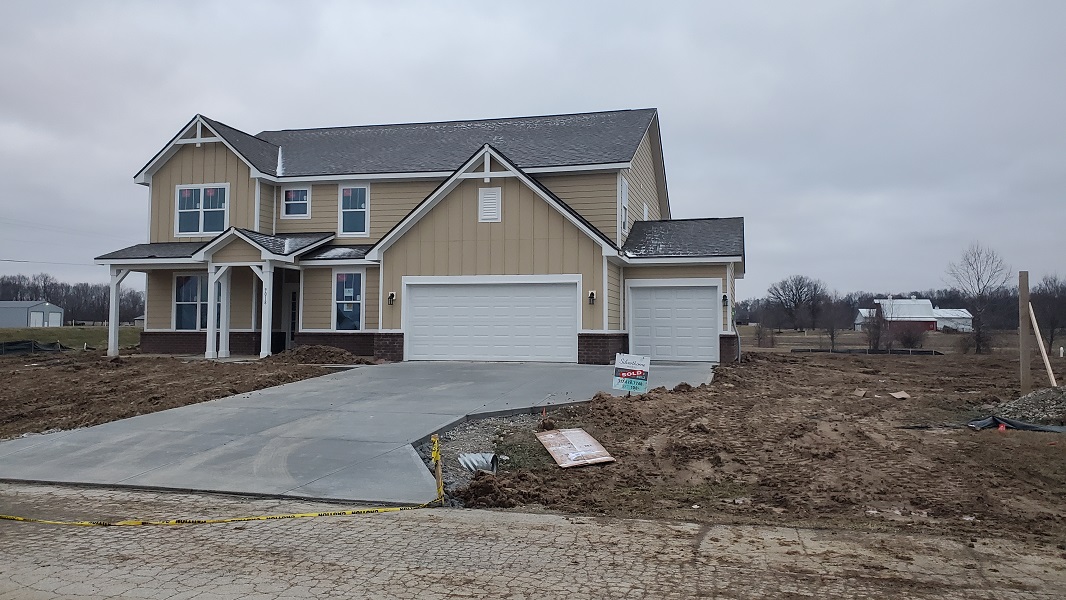

07 Jan 2023: Siding has been started.

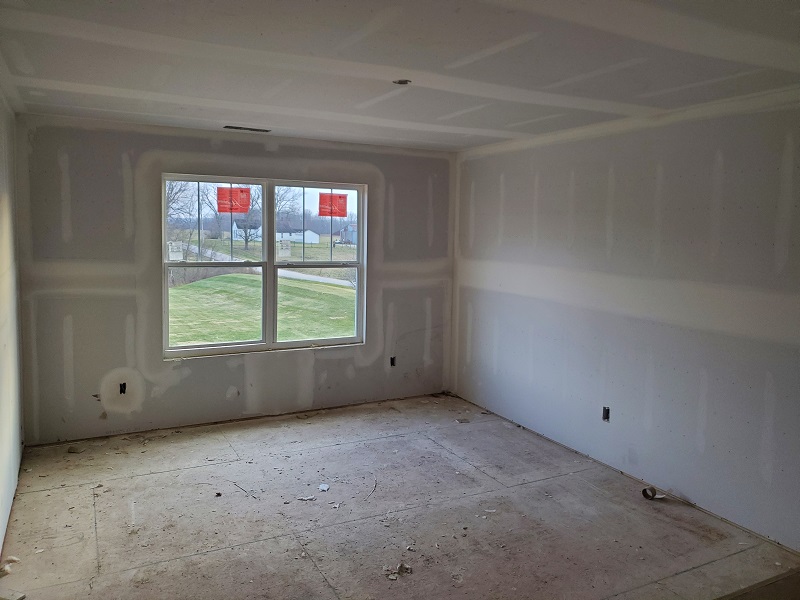

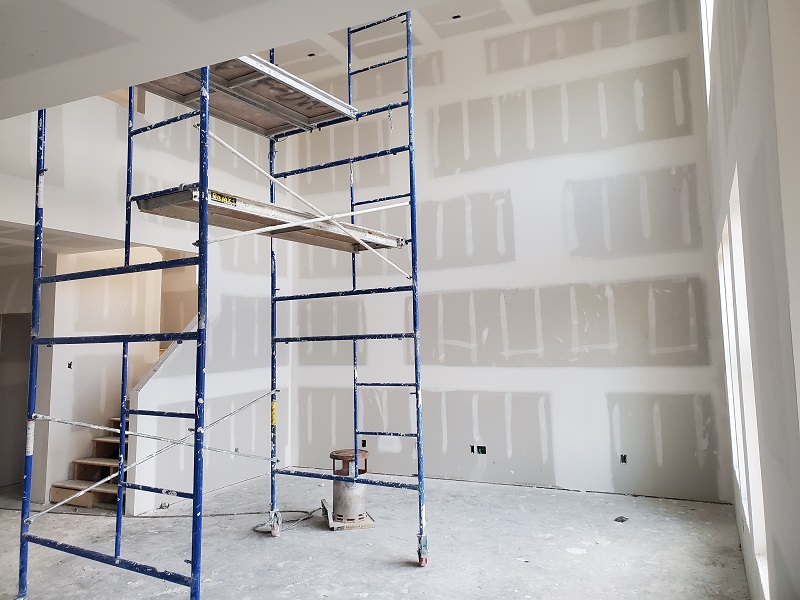

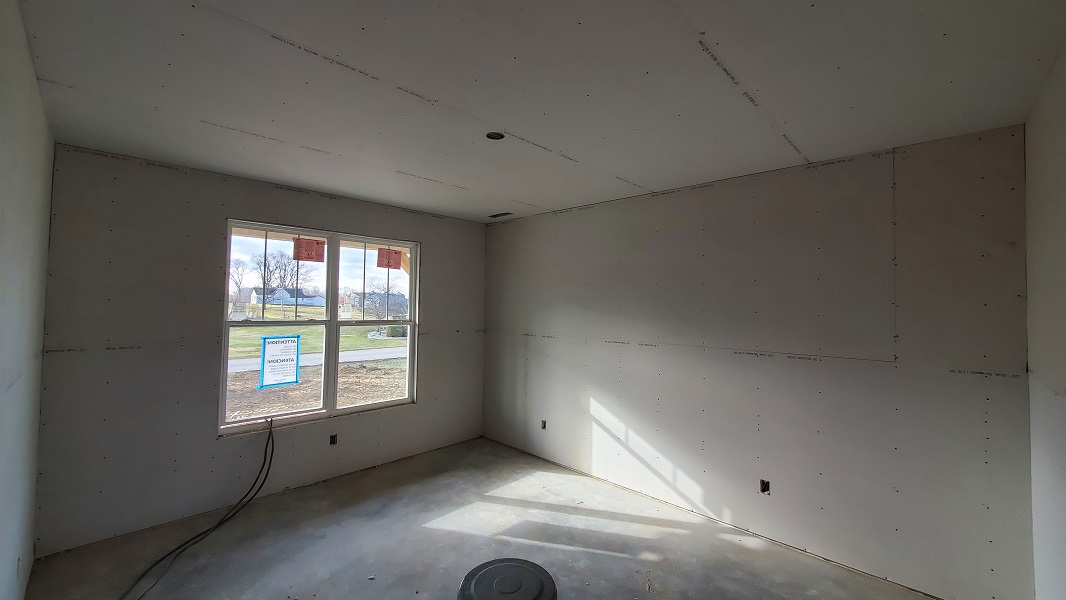

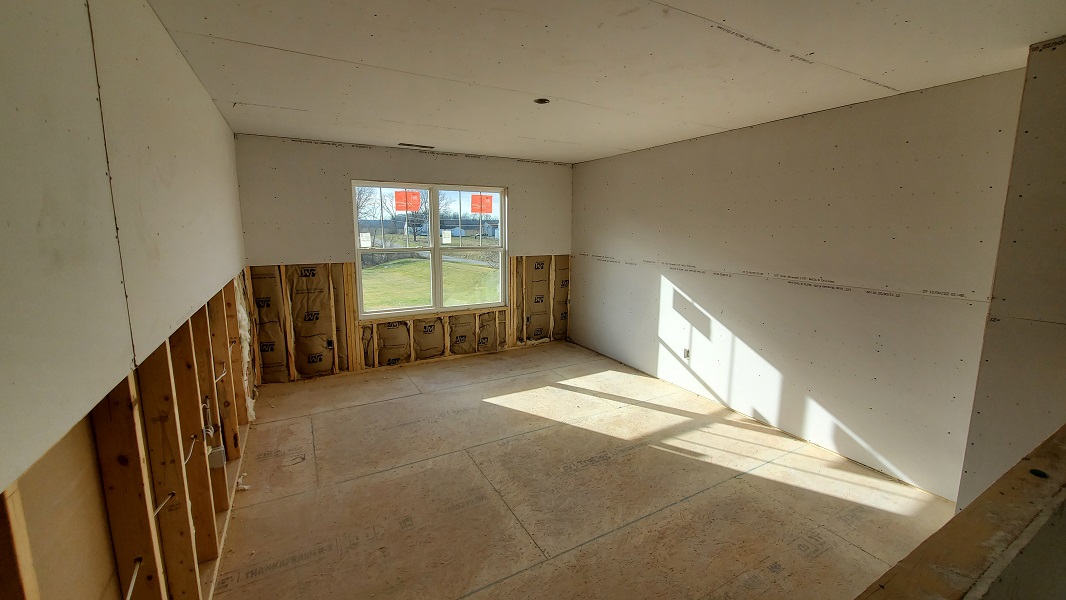

21 Dec 2022: Drywall is up and first coat of mud has been applied. Fill dirt has been dropped and is being graded around the house.

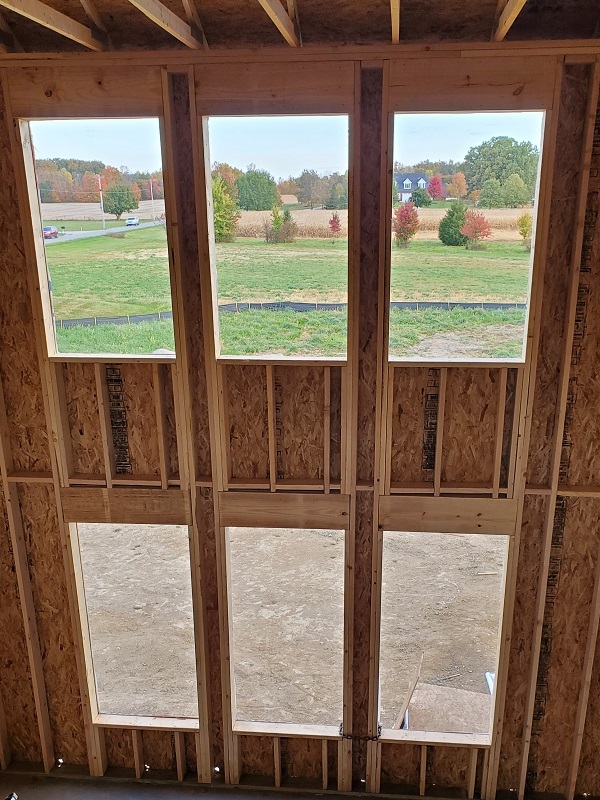

17 Dec 2022: Septic tank and finger drainage system completed.
14 Dec 2022: Hanging of drywall started.
13 Dec 2022: Interior insulation inspection completed.

08 Dec 2022: Exterior brick-work completed.

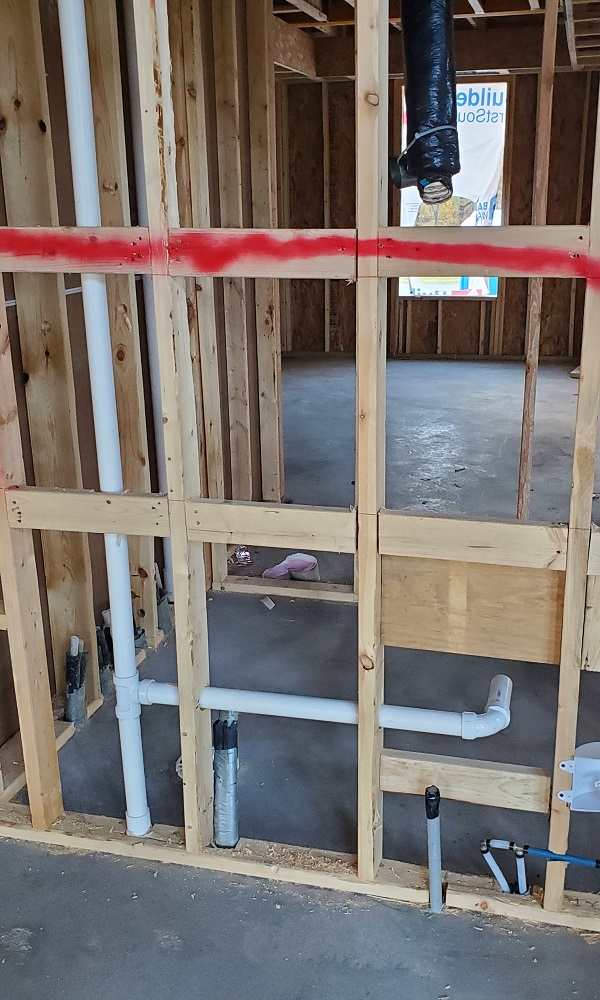

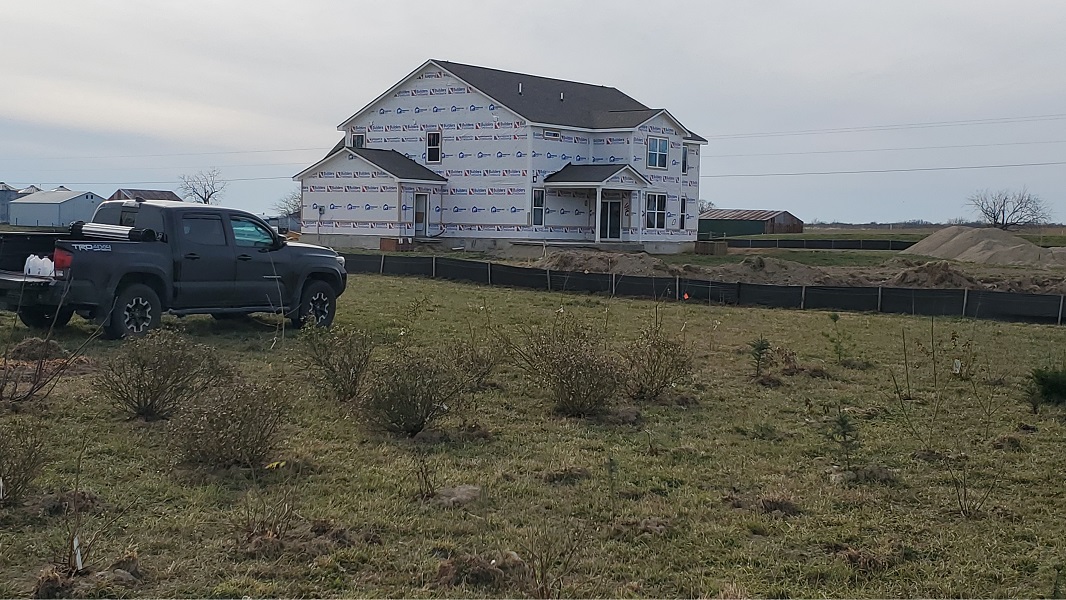

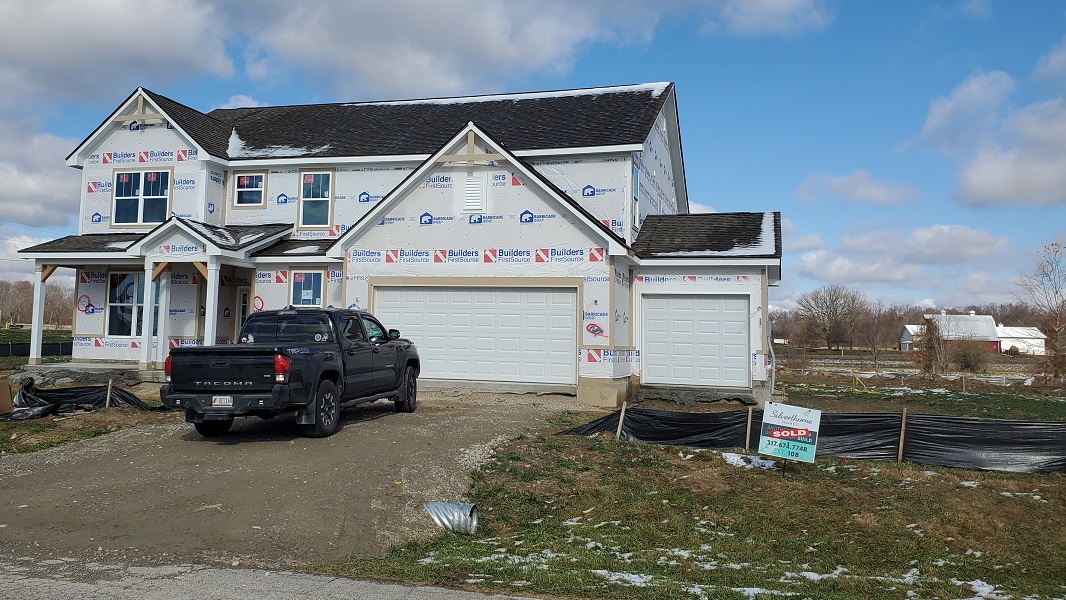

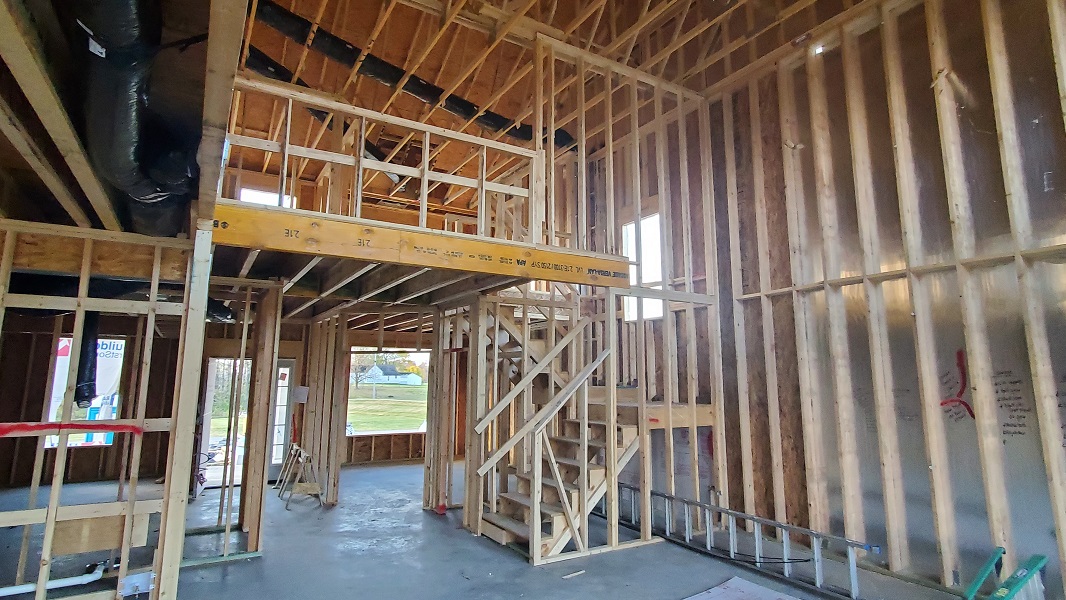

16 Nov 2022: Interior rough-ins are complete. Pre-drywall meeting held.

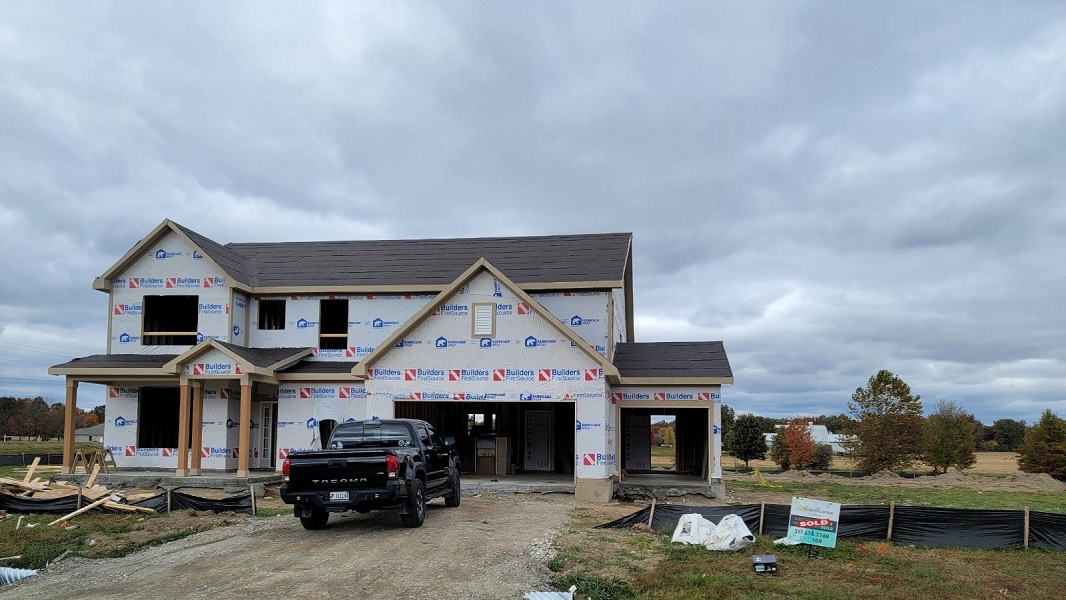

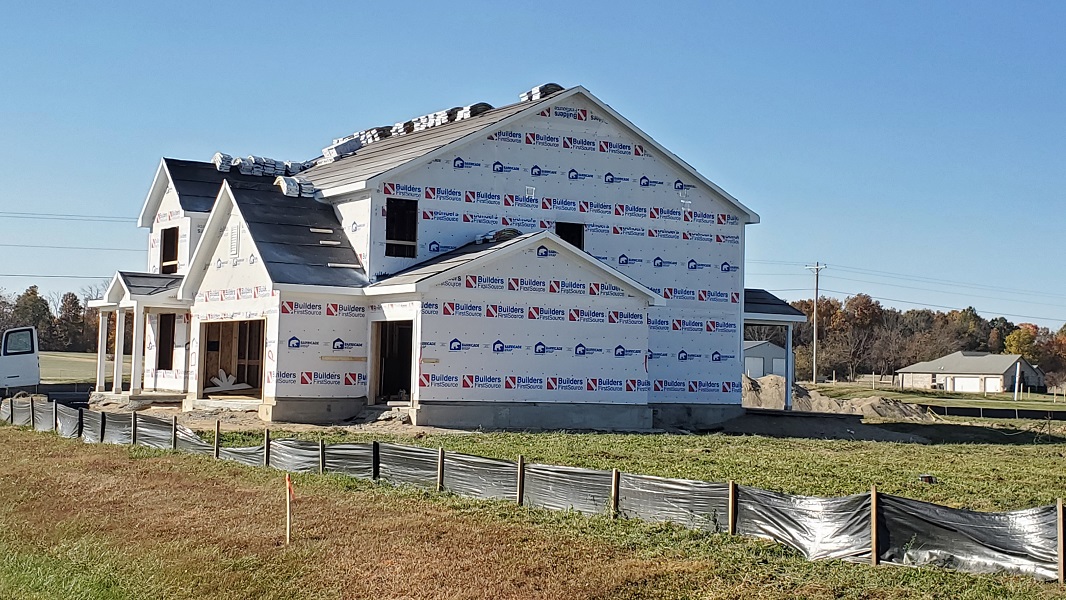

28 Oct 2022: Windows, exterior doors and roof are complete.

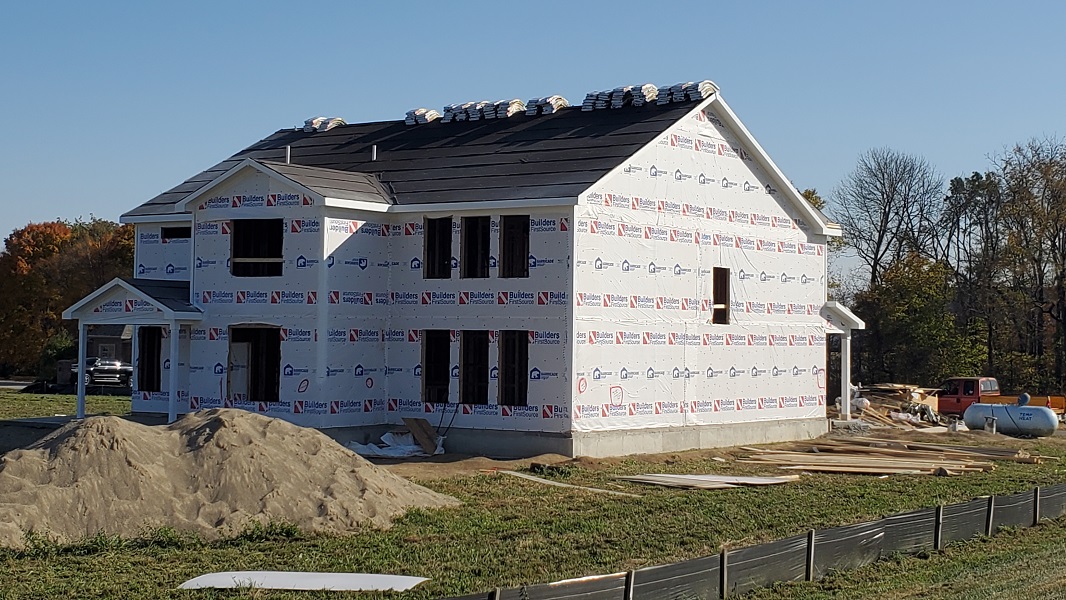

18 Oct 2022: Porch columns are installed and roof has a tar paper base.

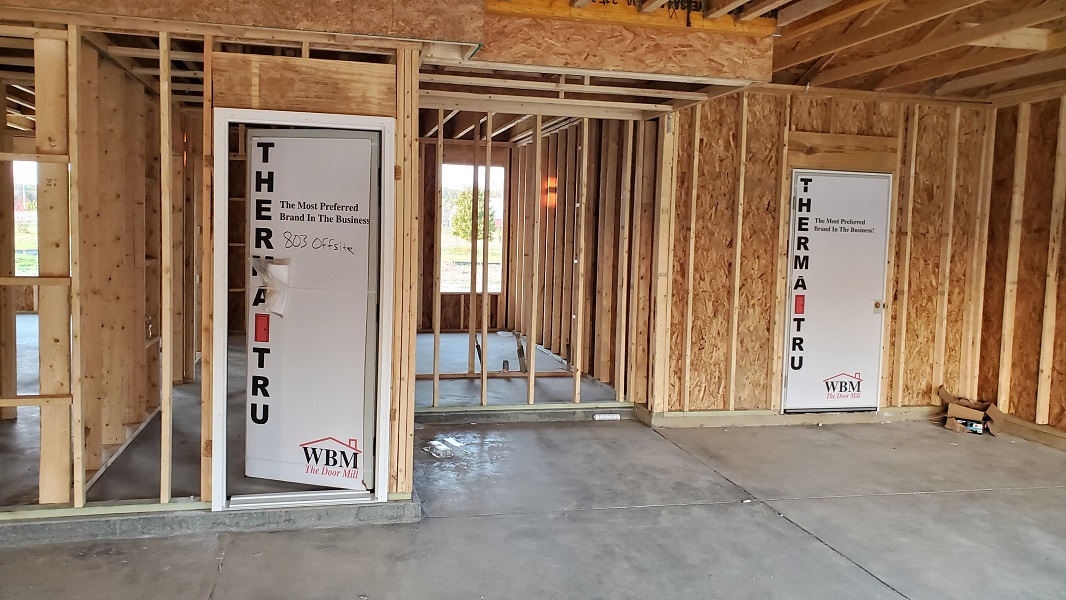

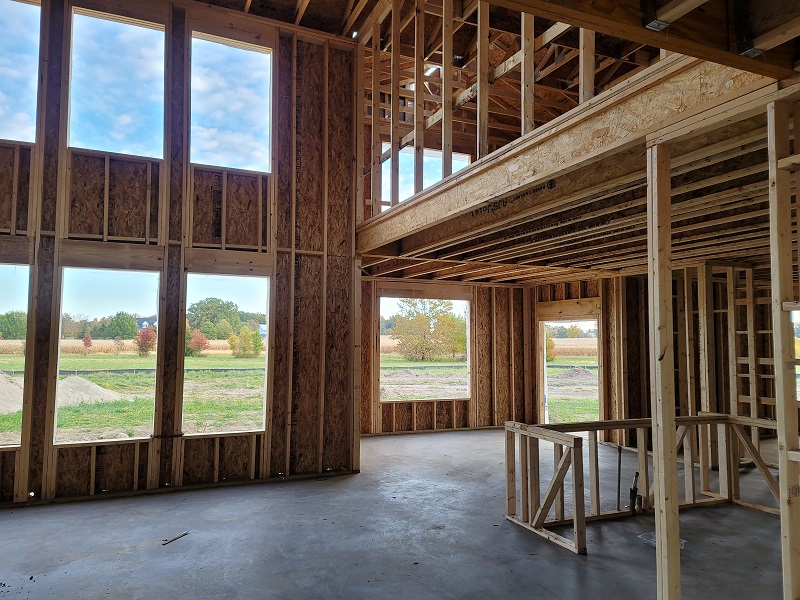

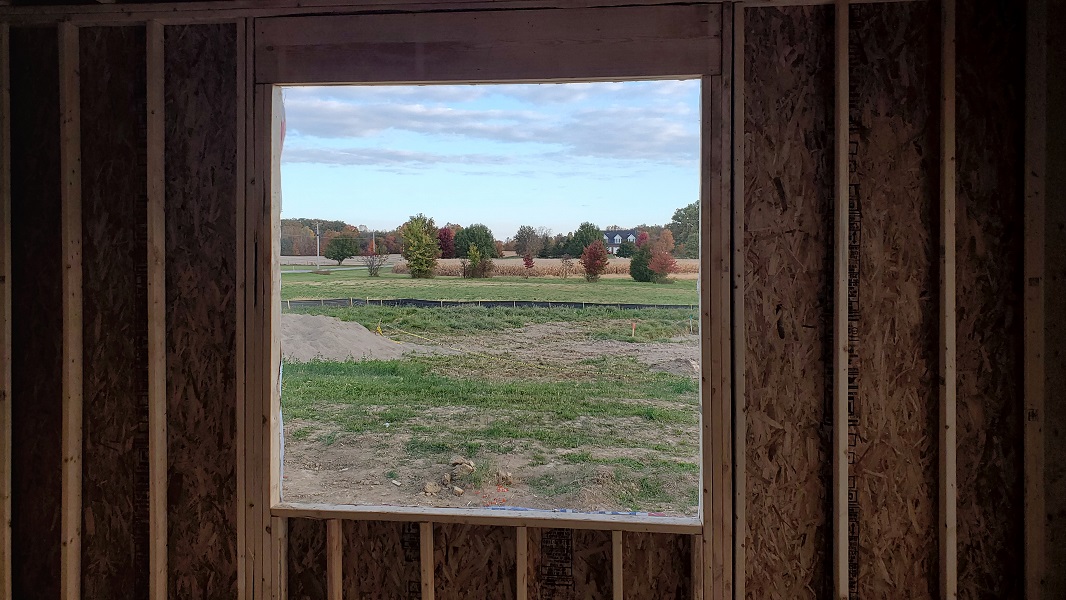

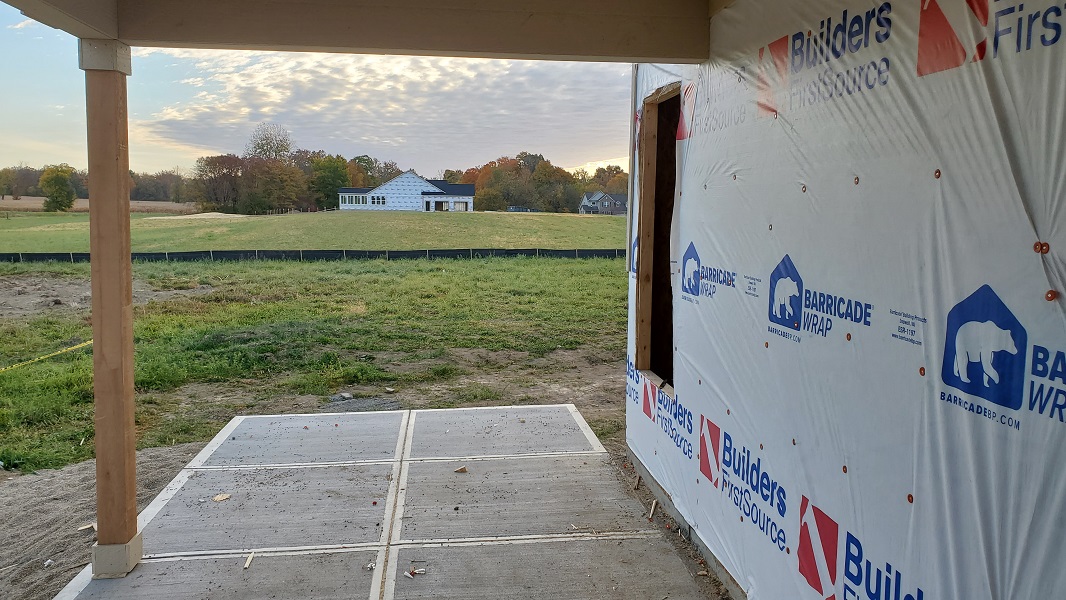

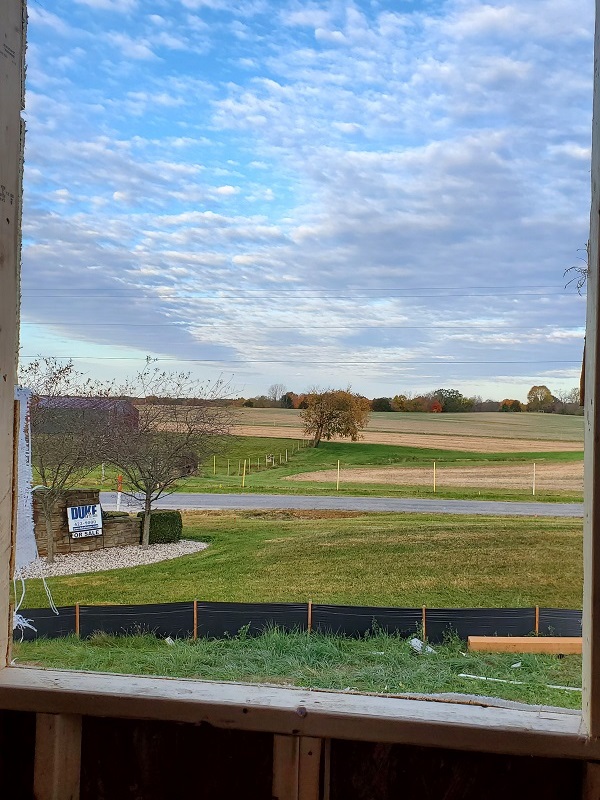

16 Oct 2022: Exterior doors have been hung.
13 Oct 2022: Second floor framing is complete and roof sheathing is installed.

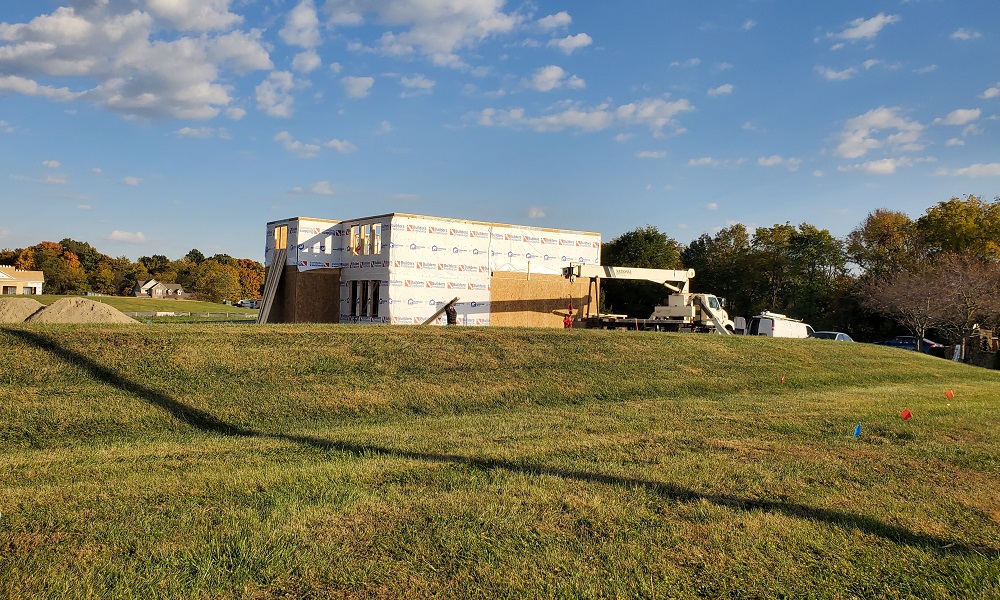

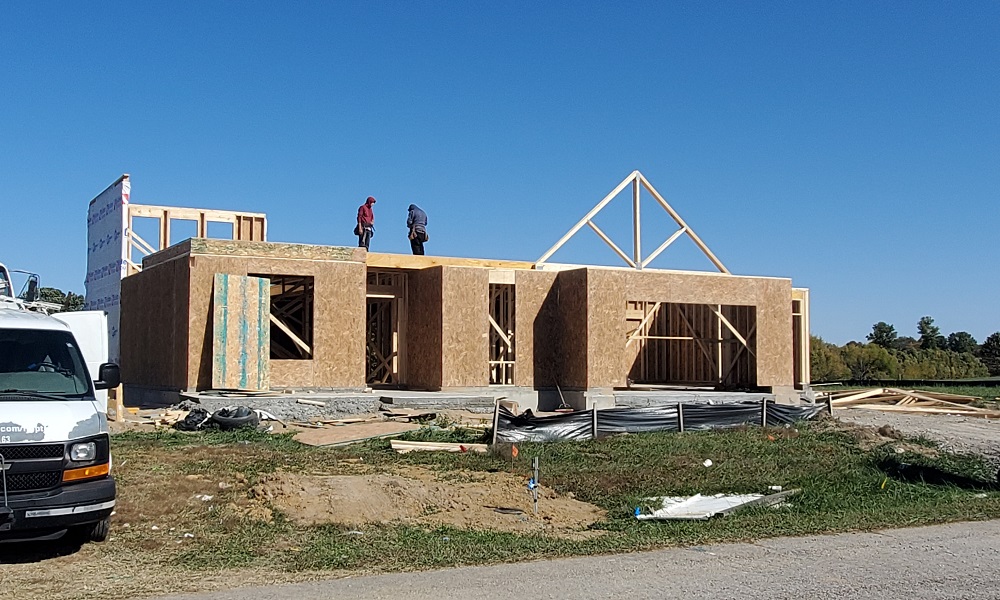

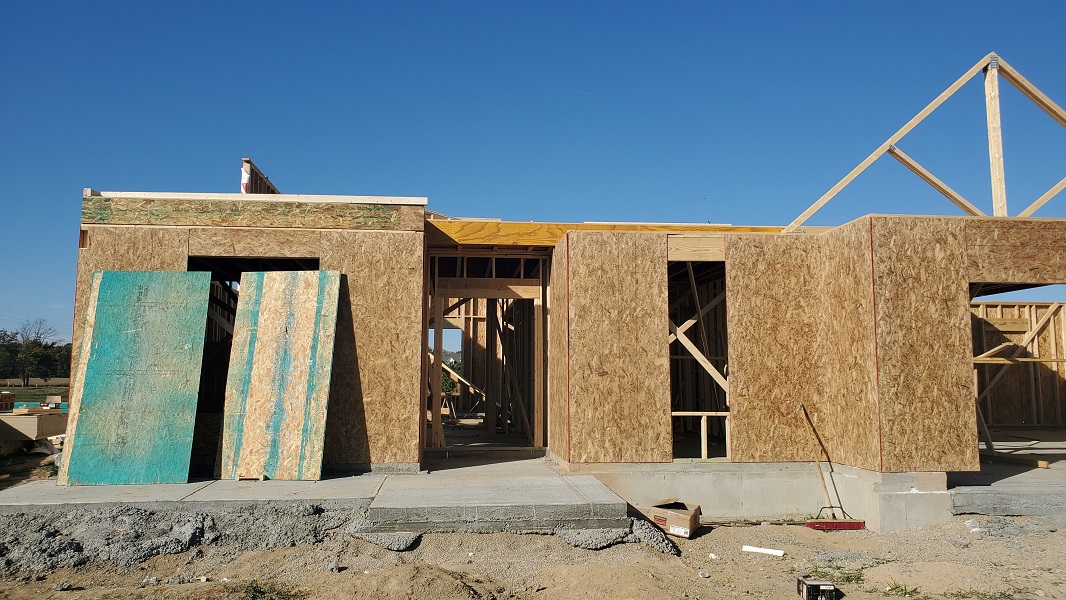

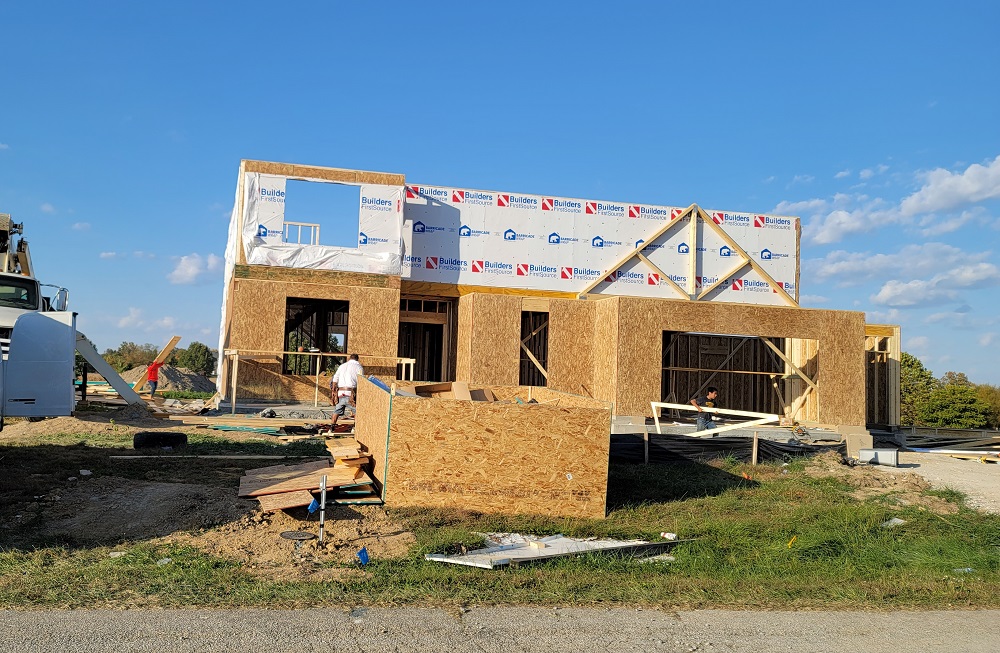

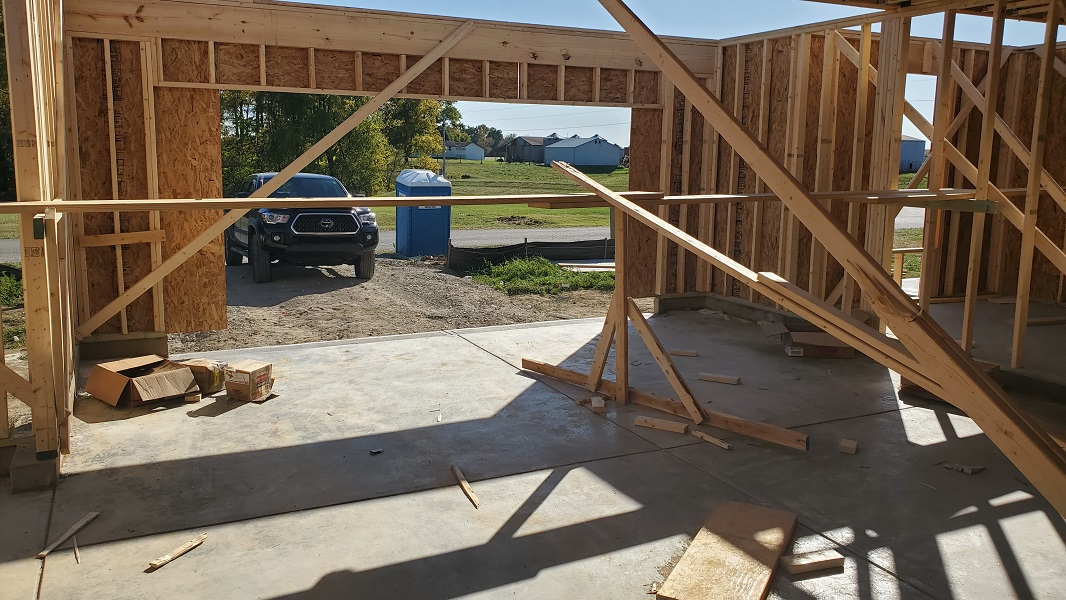

10 Oct 2022: Ground floor framing is complete.

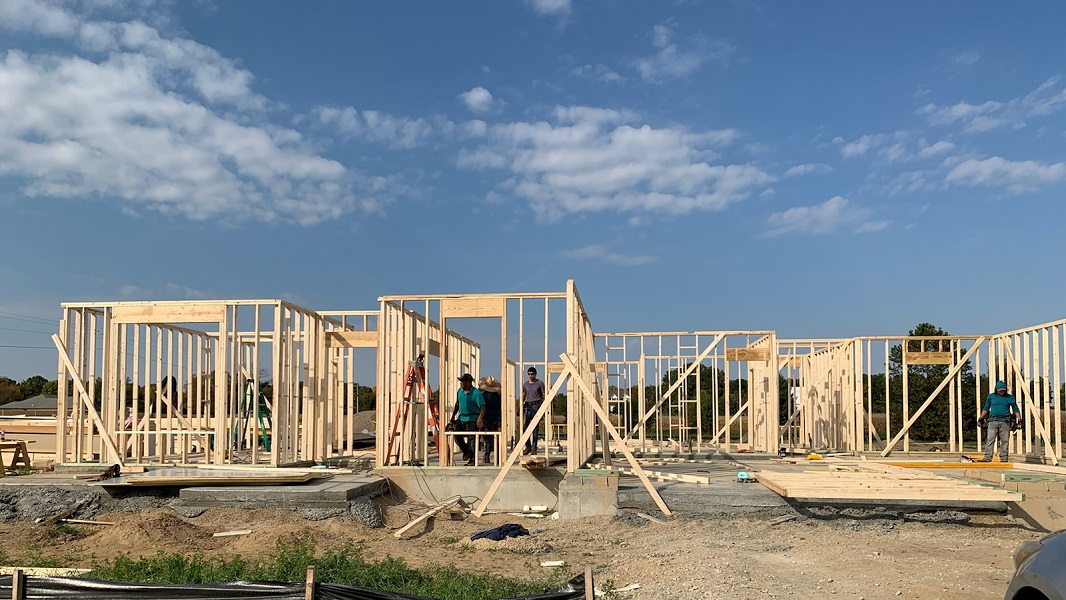

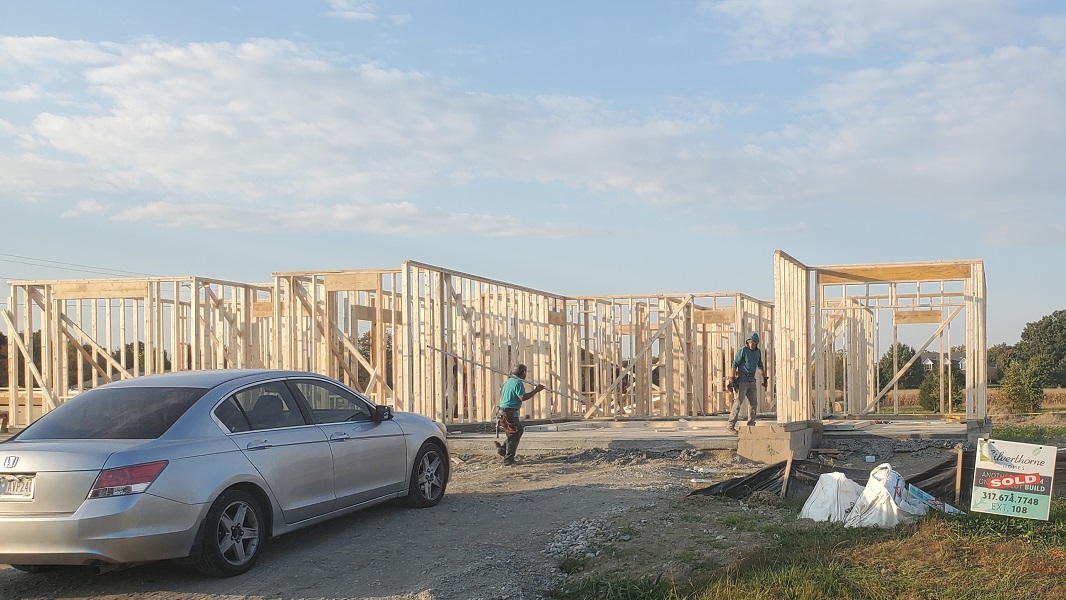

06 Oct 2022: Framing has begun.
05 Oct 2022: Slab has been poured.

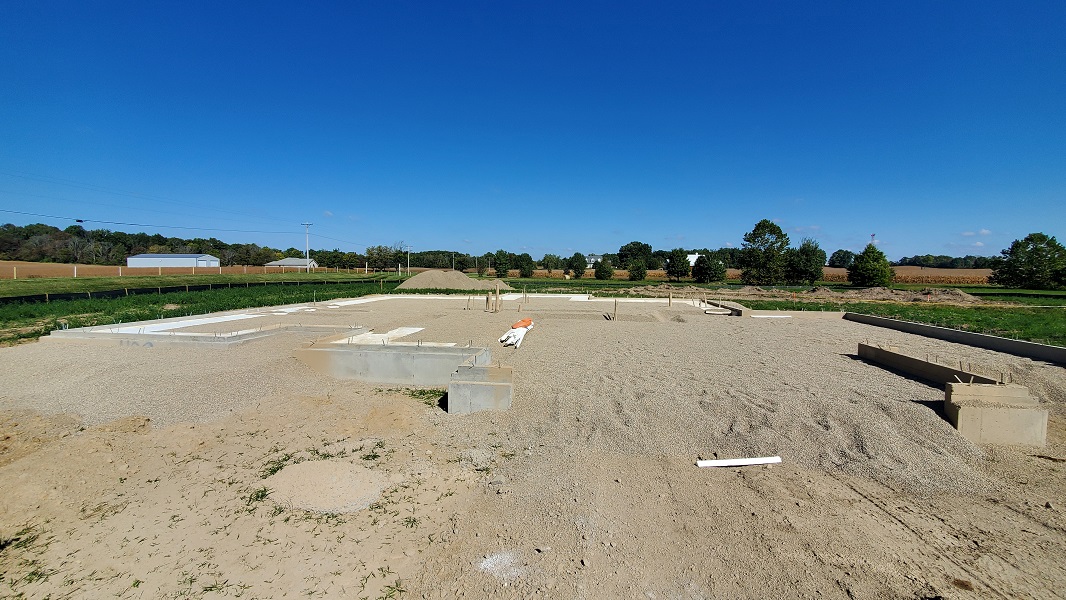

02 Oct 2022: Septic system construction has been started.
30 Sep 2022: Under-slab pea gravel has been installed in and around the foundation in preparation for the pouring of the slab.

17 Sep 2022: Under-slab piping for water and septic tank lines and water line feed from the street have been installed.

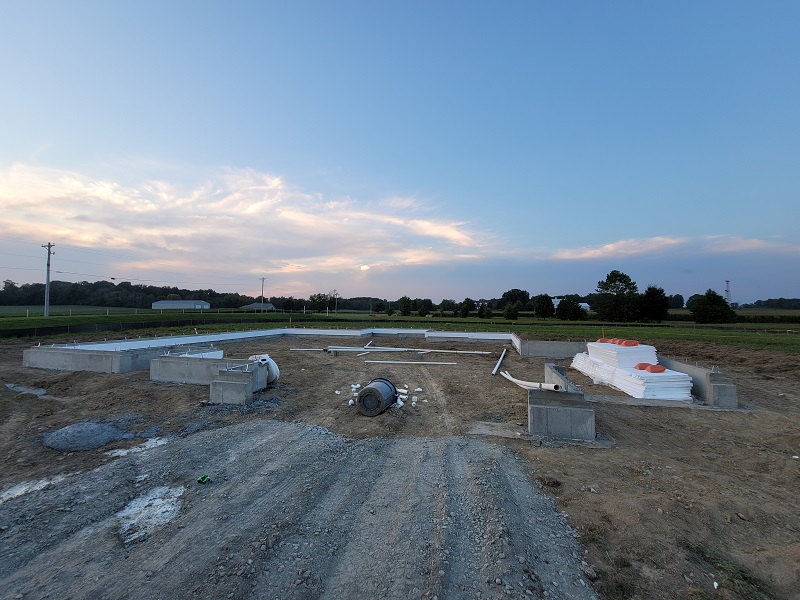

23 Aug 2022: Foundation has been poured.

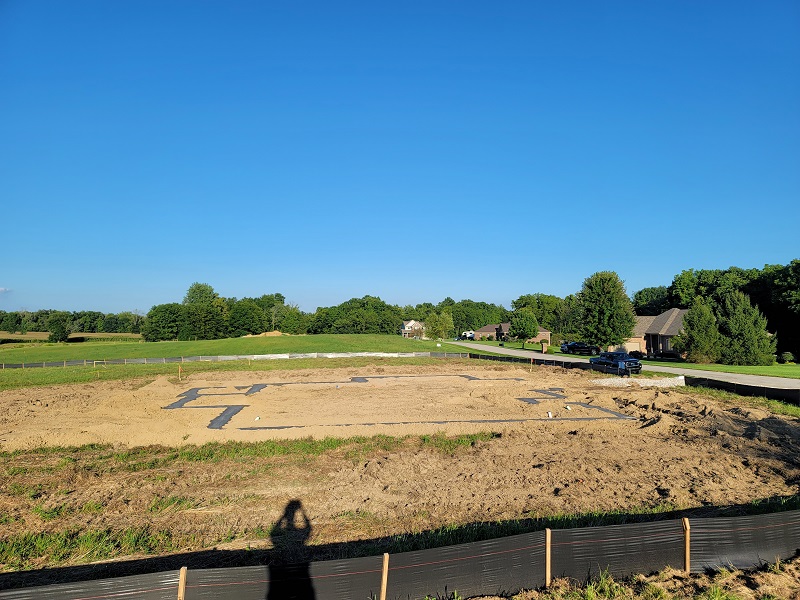

23 Aug 2022: Ground has been broken! Footers for the foundation have been poured.
11 Aug 2022: We are on the build schedule. Tentative construction start date is August 22nd.
03 Aug 2022: County permits have been approved. Waiting to get on the build schedule.
11 Jul 2022: 2 of 3 signatures acquired for changes to drainage easement. Builder is working to get final signature before they can submit to the county for the necessary permits.
31 May 2022: We have a delay in our septic system permit because of an issue with the local drainage.
25 Apr 2022: Builder is acquiring the lot and requesting the necessary permits.
22 Apr 2022: Pre-Construction Meeting completed (final design review before breaking ground).
14 Apr 2022: Pre-construction appraisal completed with our lender
11 Mar 2022: Received word that our plan has been approved by the St. John Commons HOA.
23 Feb 2022: Design Review has been completed and the down payment has been made. Colors, textures and plan details are now set. Let the games begin!
22 Jan 2022: Previewed the Silverthorne Design Center to get ideas about colors and textures.
20 Jan 2022: The Pre-design meeting has been completed.
|
